How to Track Long-Lead Materials in Your Construction Schedule

Nathan Gilmore
November 12, 2025

Nathan Gilmore is a cofounder of TeamGantt, where he leads strategy, R&D, and sales. After 5 years in commercial roofing, he saw firsthand how hard it was to create a living schedule that everyone on a project could access and rely on. That challenge inspired Nathan and cofounder John Correlli to launch TeamGantt in 2010. He believes a clear, connected schedule is key to avoiding costly delays and is passionate about helping construction teams save time, reduce stress, and eliminate waste.

Choose your template
Free, online gantt chart
Easier than Excel. Drag-and-drop editing. Over 1 million users. And completely free!
Try TeamGantt for free
Way better than an Excel template.
Boring Excel template
A standard, premade Excel RACI chart template for assigning project roles.
Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.
Enter your email to download.

Long-lead materials don’t just delay jobs. They can unravel your entire schedule if you’re not tracking them right.

I’ve talked with enough builders, and here’s what I’ve learned:

Missed orders don’t happen because people don’t care. They happen because systems can’t keep up.

Crews want to stay ahead. But when install dates shift and order deadlines don’t follow? That job’s already behind.

In this guide, I’ll show you how to fix that. You’ll learn:

  • What material lead time actually means (and how to calculate it)
  • Why most procurement systems break down
  • How to track long-lead materials in your schedule
  • How TeamGantt helps you tie it all together

What is material lead time?

Material lead time is the number of days or weeks it takes for a material to arrive after it’s been ordered. Think of it as the duration between placing the order and on-site delivery.

Anything with a lead time of 4 weeks or more should be flagged as a long-lead item. Track these materials directly in your construction scheduling software so deadlines stay in sync with your project timeline.

When managing material lead times, you’ll work with 3 key dates:

  • Install date: The date the material is scheduled for installation
  • ROJ (required on job) date: The date the material must be on-site to avoid project delays
  • Order date: The latest date you can place the order to meet the ROJ date

Common long-lead items to track

Some materials consistently show up as delay risks. Make sure you’re flagging these in preconstruction:

  • Custom windows and doors
  • Cabinet packages and millwork
  • HVAC equipment and controls
  • Structural steel or engineered framing systems
  • Imported tile or finish materials
  • Switchgear and electrical panels
  • Elevators and specialty mechanical units

If it’s custom, overseas, regulated, or relies on other approvals first, it’s probably a long-lead item.

Why material orders still get missed

Even when teams do the work upfront—identifying long-lead items, calculating order dates, and building procurement into the preconstruction plan—things often fall apart in the field.

Here’s where things usually break down:

1. Procurement lives outside the schedule

Most teams track install dates in one place and materials in another.

So when the schedule shifts—and it always does—the order deadlines don’t shift with it. And because those dates aren’t visible to the full team, no one notices until it’s too late.

Sometimes the plan was solid. The team worked backward from the install date. Milestones were mapped. But a permit got delayed. Submittals dragged. Weather rolled in.

And suddenly, that carefully calculated order date is off. But no one recalculates because the system isn’t built for it.

It doesn’t matter whether you use sticky notes or software. If procurement doesn’t live inside the schedule, it won’t adapt when reality hits.

2. Manual systems break under pressure

A whiteboard might work for 3 crews—but not 25.

One builder told me their spreadsheet was such a pain to update that when they fell behind, orders slipped through the cracks.

When install dates live in one file and materials in another, someone has to remember to manually reconcile the two every time the schedule changes.

And if that spreadsheet lives on someone’s desktop? The rest of the team is flying blind.

3. Tools that aren’t built around the schedule

Tools like Buildertrend, CoConstruct, and Procore help builders manage communication and documentation. But I hear the same complaint over and over:

They don’t connect procurement to the live schedule.

So teams fall back on spreadsheets, inboxes, and memory.

When materials aren’t visible in the timeline—and the timeline is always moving—orders slip. And the ripple hits every job you’re juggling.

Signs your procurement system isn’t working

Here are a few signs your current setup isn’t built to prevent construction delays:

  • Materials tracked in spreadsheets, whiteboards, or emails
  • Long-lead items flagged in precon—but never tracked again
  • Install dates shift, but order deadlines don’t move with them
  • No regular review of upcoming ROJ dates
  • No clear owner assigned to procurement
  • Teams get blindsided—even when the info “existed somewhere”

Missed orders don’t just stall your project. They undermine your trust, margins, and momentum.

One GC put it best:

“Having our sign out front for a year and a half, when the job was supposed to take 8 months? That’s not good. Luckily, we’ve had some sympathetic clients—but it only takes one to ruin our reputation.”

If your schedule isn’t helping you spot risk early and adjust in real time, it’s not doing its job. That’s why schedule-driven procurement gives you a strategic advantage.

Keep the big picture in easy view

Lay a clear path to success with a visual plan that’s easy to understand, and keep everyone in sync with flexible workflows and team collaboration.

Create your free plan

How top teams stay ahead of long-lead issues

When I talk to builders who consistently stay on track, I notice they handle material lead times very differently. These habits separate builders who stay on schedule from those who constantly fight fires.

Track procurement inside your schedule

When you track procurement inside your schedule—using fields like Required on Job (ROJ)—you make risks visible before they become issues. I always recommend teams start their week by filtering the schedule for ROJ dates and tackling that list together.

Use dependencies to automate order timing

Don’t rely on memory to adjust your order dates. When you link your material orders to install tasks using dependencies, those order dates move automatically when the schedule shifts. It’s a small adjustment that makes a huge difference in keeping orders on time.

Build accountability into the system

If everyone owns it, no one owns it. That’s why I suggest assigning every long-lead item to a specific person in the schedule. Have that person update the schedule directly so everyone knows what’s been ordered and what’s still open. Then set up an automatic reminder a week before the ROJ date to trigger a quick status check.

Run a weekly rhythm

Treat procurement as a scheduled activity, not an afterthought. This is one of the simplest ways to avoid surprises. I recommend running a simple Monday check-in to review upcoming ROJ dates and knock out orders in one focused batch. It turns guesswork into a repeatable routine.

How to calculate order deadlines

A lot of construction schedule delays trace back to one simple miss: the order deadline wasn’t right (or didn’t get updated when things changed).

To calculate the order date, simply subtract the lead time from the ROJ date.

ROJ Date – Lead Time = Order Date

Let’s say you’ve got windows scheduled for install on October 28. You want them on site 3 days early, so your ROJ date is October 25. Your supplier needs 6 weeks of lead time.

That means you’ll need to place the order by September 13 to keep the job on track.

October 25 – 6 weeks = September 13

The math’s easy. The hard part is remembering to recalculate when things shift. That’s why smart teams build habits—and systems—that handle the math for them.

In TeamGantt, the order date is auto-calculated for you. Just enter the ROJ date and lead time, and we’ll do the rest!

How we designed material tracking in TeamGantt

The right tools should make these tips easy to follow, not harder to manage. That’s why we designed TeamGantt’s Construction Edition to support these habits right out of the box.

In nearly every customer interview, material lead times came up. So we asked: What would it take to turn these proactive habits into something teams could actually stick to?

TeamGantt lets you manage procurement directly in your Gantt chart. It’s built to help you:

  • Flag long-lead materials and track their ROJ dates
  • Store POs right next to the materials they cover
  • Assign owners and track order status
  • Automatically adjust deadlines as the schedule evolves

Our goal wasn’t to add more clicks. It was to make long-lead tracking automatic, visible, and tied to the schedule. That way, nothing falls through the cracks.

Here’s how each feature supports the habits we just walked through.

Everything stays on one line.

Most tools force you to create multiple tasks—one for installation, one for ordering, one for delivery. That clutters your chart and creates more places for things to go wrong.

In TeamGantt, your install date, ROJ date, lead time, and order deadline all live on the same task. It’s simple, visual, and keeps your schedule clean—without extra rows or jumping between views.

Dates move when the schedule does.

If you shift the install task, TeamGantt automatically adjusts the lead time marker and ROJ date. No recalculating. No manual updates. TeamGantt keeps everything aligned so your lead times stay accurate, even when the schedule changes.

You can filter by urgency.

Filter your schedule by what needs to be ordered this week, what’s overdue, or what’s coming up. That makes a Monday procurement rhythm easy and effective. You can proactively tackle procurement instead of reacting when it's too late.

Status tracking keeps everyone aligned.

Every material gets a clear status—ordered, delayed, or delivered. You can assign a purchaser, upload a PO, and track how many days are left until the order is due. It keeps everyone on the same page.

Book a free demo to get an up-close look at the workflow in action.

How to track long-lead items in TeamGantt

From automatic order dates to visual tracking, we built this workflow to stay aligned with your schedule. Let’s walk through how it works, step by step.

1. Click “Track materials” next to the installation task

Hover over the install task bar in your Gantt chart. Click the Track materials triangle icon to open the material tracking window.

TeamGantt Gantt chart displaying a construction task titled “Roof Framing” in the timeline. A gray triangle icon appears to the right of the task bar with a visible tooltip labeled “Track materials.” The interface also shows task bars and progress indicators for related tasks like “Wall Framing” and “Window and Door Installation.”

2. Add the Required on Job (ROJ) date

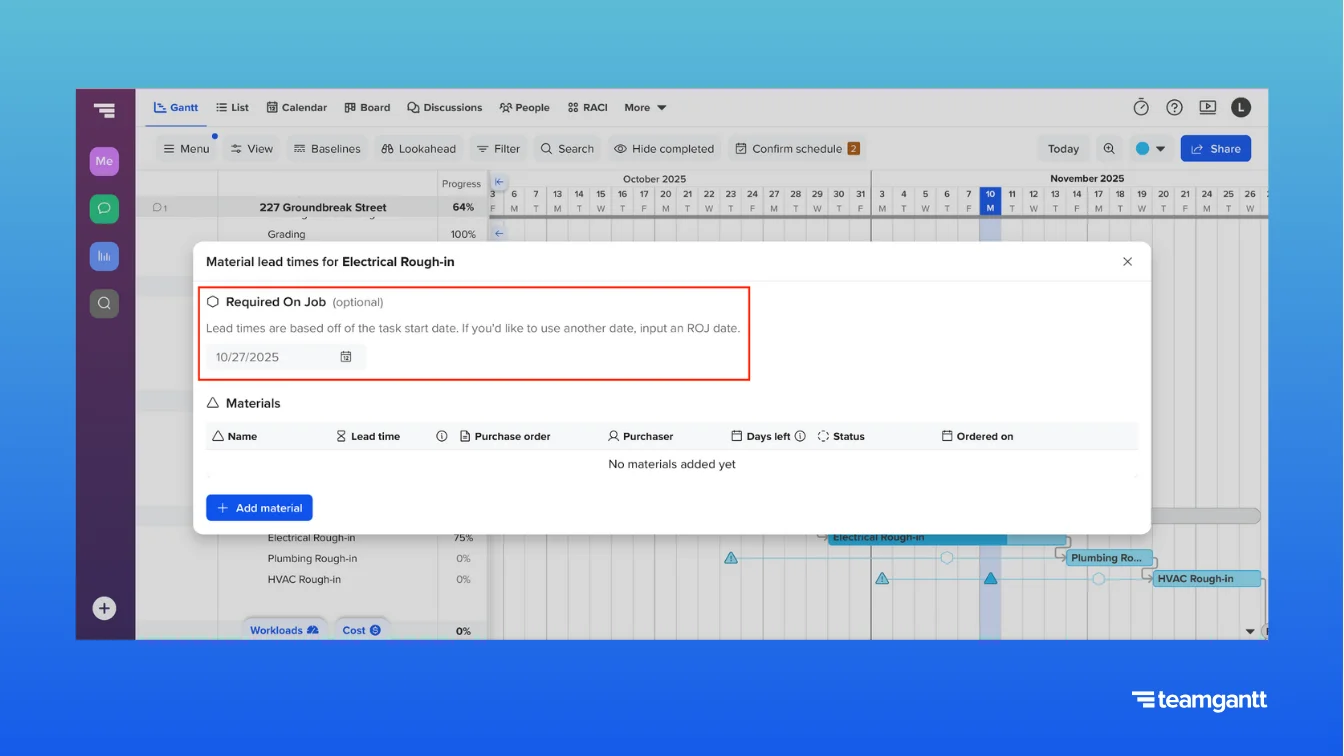

At the top of the material tracking window, enter the ROJ date. This is the date all materials for this task need to be on-site.

Material tracking window in TeamGantt titled “Material lead times for Electrical Rough-in.” A Required On Job (ROJ) date field appears at the top, showing a selected date of 10/27/2025. Instructional text below the label reads: “Lead times are based off of the task start date. If you’d like to use another date, input an ROJ date.” The rest of the window includes a materials table with columns for name, lead time, purchaser, and status, but no materials have been added yet.

Tip

The ROJ date applies to all materials added to this install task. If left blank, TeamGantt will default to the task’s start date.

3. Add each material as a line item

Click + Add material to create a row for each item you need to track. This keeps materials organized and tied directly to the install task.

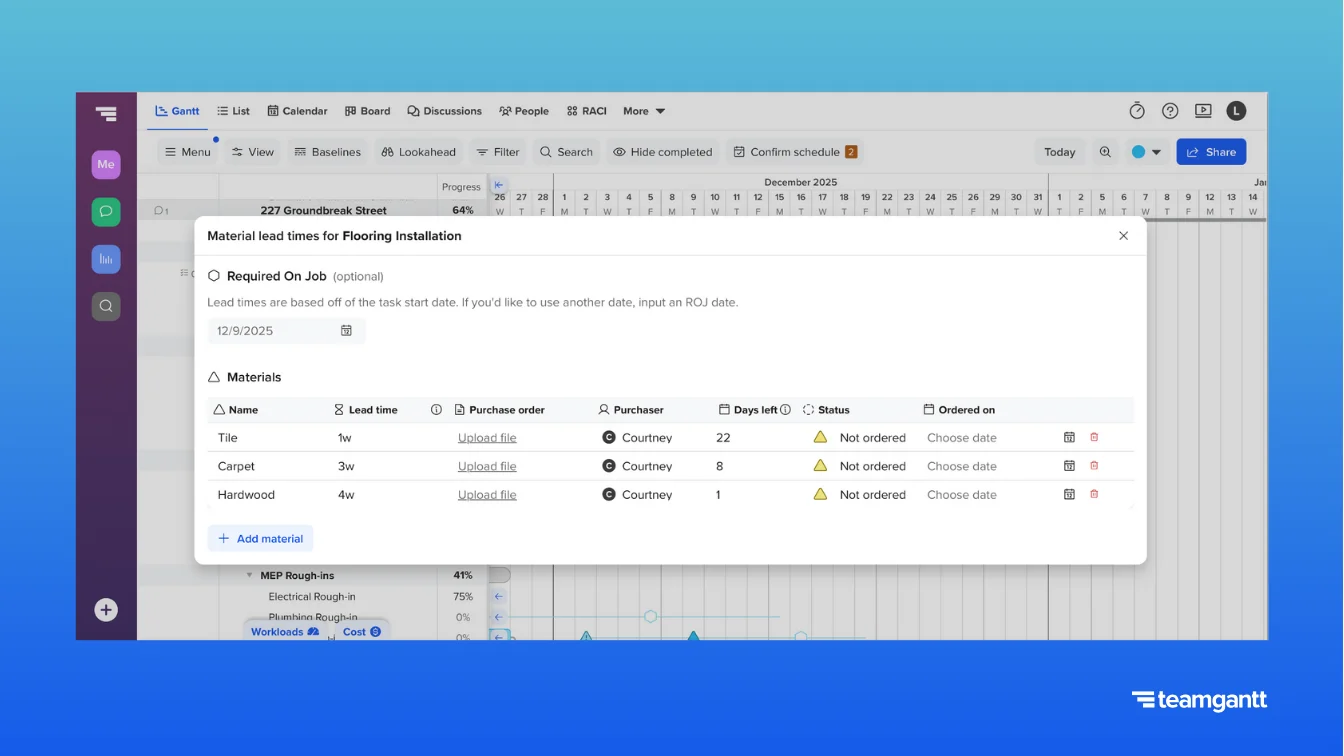

Material tracking window in TeamGantt for the task “Flooring Installation.” Three materials—Tile, Carpet, and Hardwood—are listed in a table with columns for lead time, purchase order, purchaser, days left, status, and ordered date. Each row shows Courtney as the purchaser and a yellow triangle icon with the status “Not ordered.” The “Add material” button appears below the list, and the ROJ date is set to 12/9/2025 at the top.

4. Enter the lead time

Add the amount of time it will take each material to arrive after placing the order. Use the format 0m 0w 0d to enter lead time.

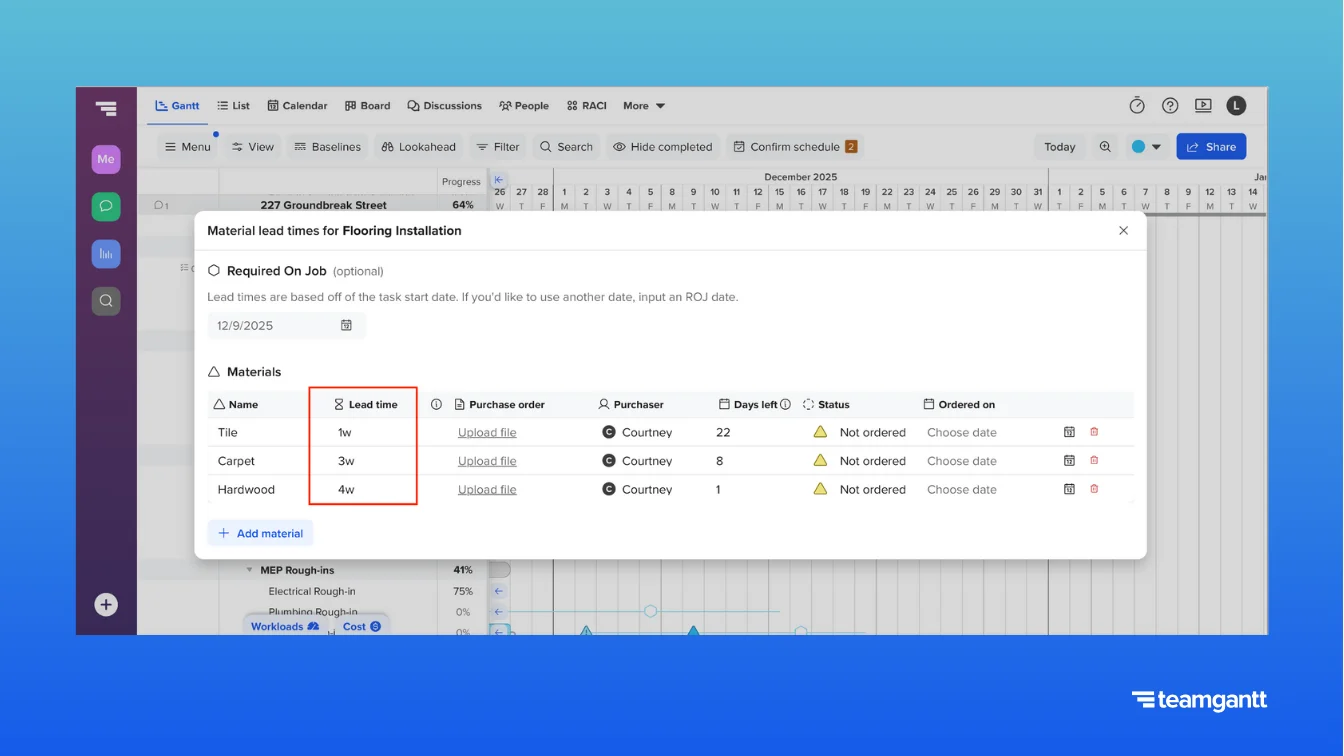

Material tracking window for “Flooring Installation” in TeamGantt, showing three materials—Tile, Carpet, and Hardwood—each with lead times entered in the Lead time column: 1w, 3w, and 4w respectively. The Required On Job date is set to 12/9/2025. Other columns include purchase order upload links, purchaser assignment to Courtney, days left, status, and ordered date. All materials are marked “Not ordered” with yellow triangle icons.

Tip

Once you enter the ROJ date and lead time, TeamGantt automatically calculates the order deadline and marks it on the schedule.

5. Assign a purchaser

Select the person responsible for placing each material order. This adds an extra layer of accountability to your procurement process.

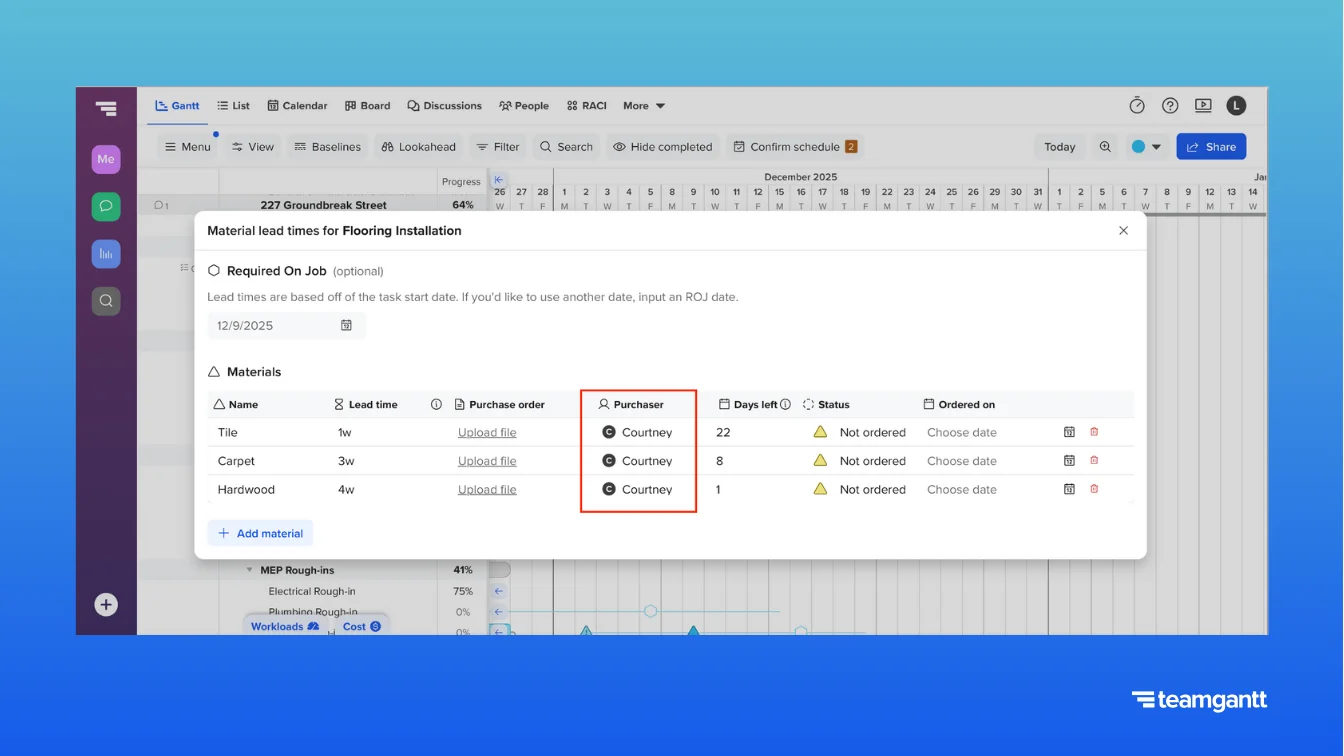

TeamGantt material tracking window for “Flooring Installation” with three listed materials: Tile, Carpet, and Hardwood. Each material has “Courtney” assigned as the purchaser in the Purchaser column, indicated by a user avatar with the letter C. Other fields include lead time, purchase order upload links, days left, order status, and ordered date. All materials are still marked as “Not ordered.”

6. Set the initial order status

When you add a material, the default status is Not Ordered. Leave it as-is if you haven’t placed the order yet, or update it to Ordered, Delayed, or Delivered as needed.

Material tracking window in TeamGantt for the “Flooring” task. In the Status column, a dropdown menu is expanded for the material “Carpet,” displaying four order status options: Not ordered, Ordered, Delayed, and Delivered — each marked with a yellow triangle icon that grows darker in shade as progress increases. The current status for all materials is set to “Not ordered.” Additional columns show lead times, purchaser, days left, and ordered date.

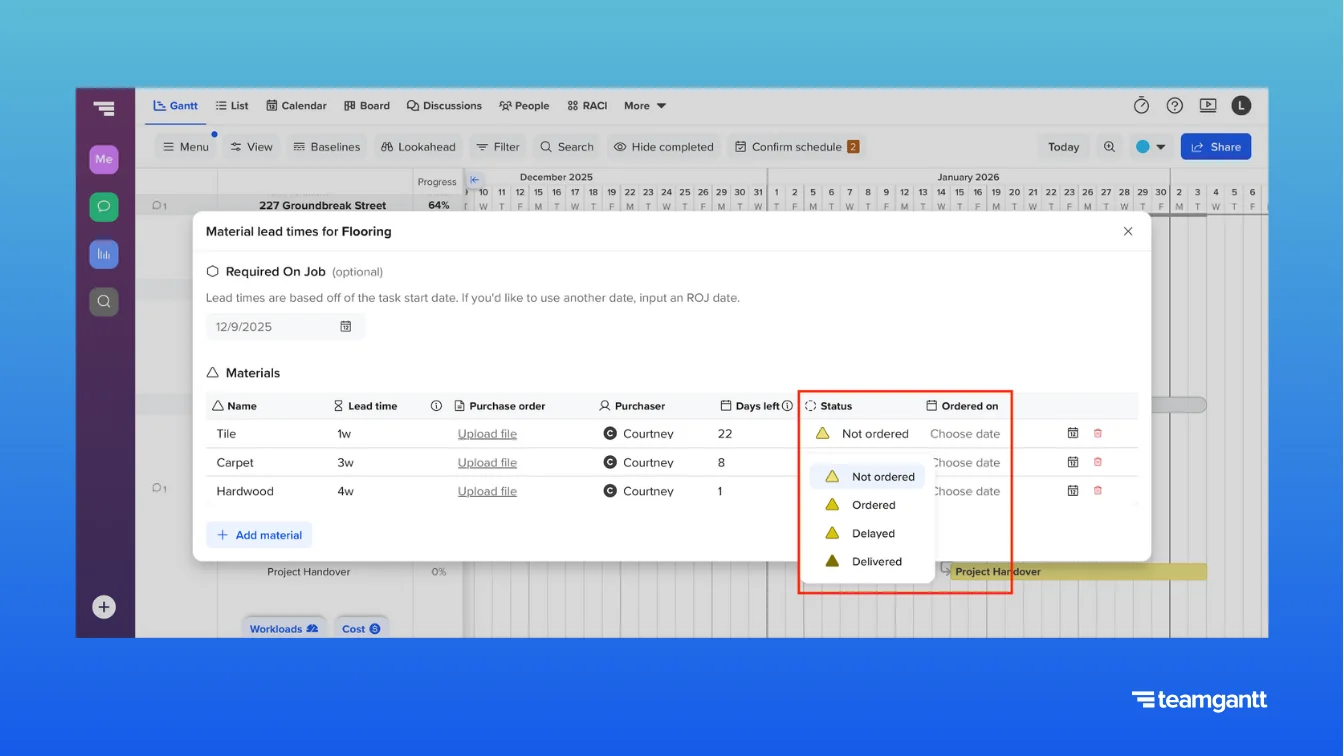

7. Track order status as your project progresses

Use status updates to stay on top of procurement as your project moves forward. As materials are ordered and delivered, update the status and order date.

Visual guide for Gantt chart icons

Each material appears as a triangle to the left of the install task bar in your Gantt chart.

  • Light-shaded triangle = Not ordered
  • Medium-shaded triangle = Ordered
  • Dark-shaded triangle = Delivered
  • Exclamation mark = Overdue (order is past due)

The ROJ date is marked by a white hexagon, making it easy to see when materials are due on-site.

These visual markers help you instantly spot what’s on track and what still needs attention, right from your schedule.

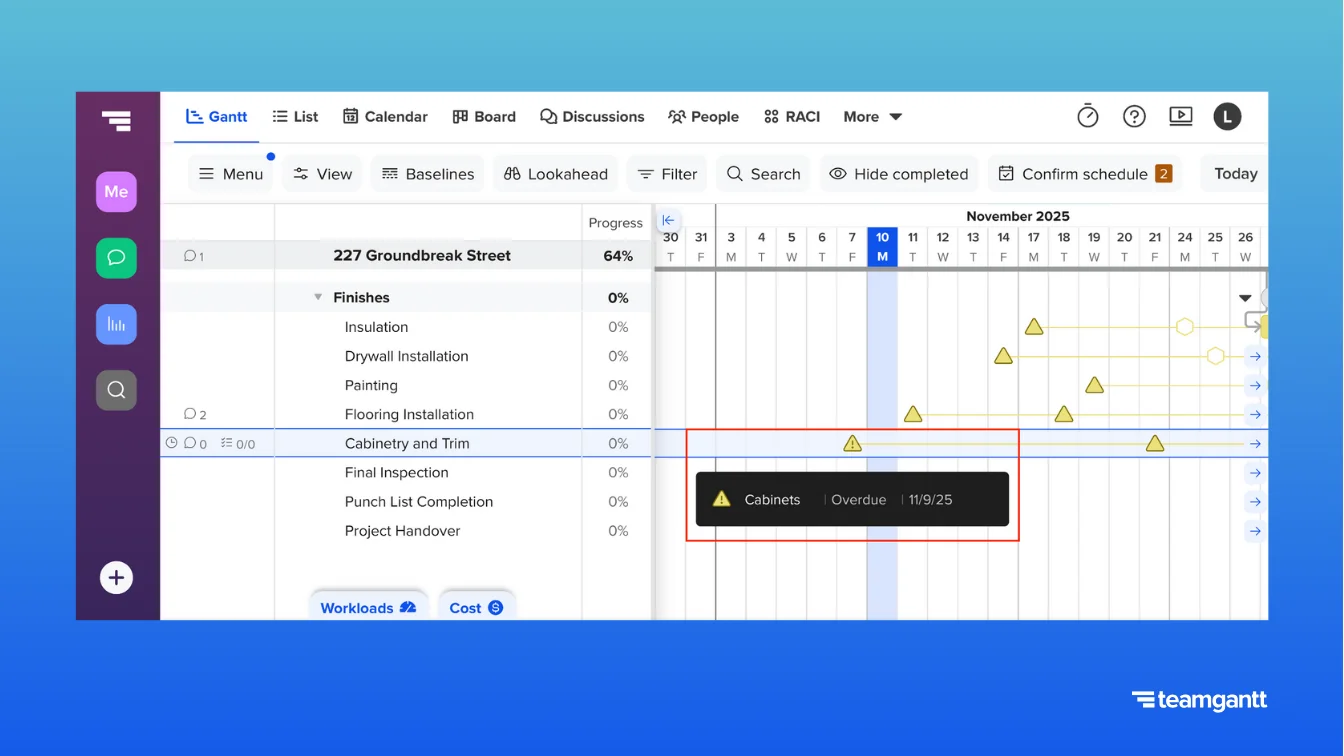

TeamGantt gantt chart showing the “Cabinetry and Trim” task with a warning icon next to the task bar. A tooltip is expanded, displaying material tracking info for “Cabinets” with an overdue status and the date 11/9/25. Several other yellow triangle icons appear across the timeline, each indicating different material statuses. A white hexagon marks a Required On Job date for another task.

8. Attach a purchase order

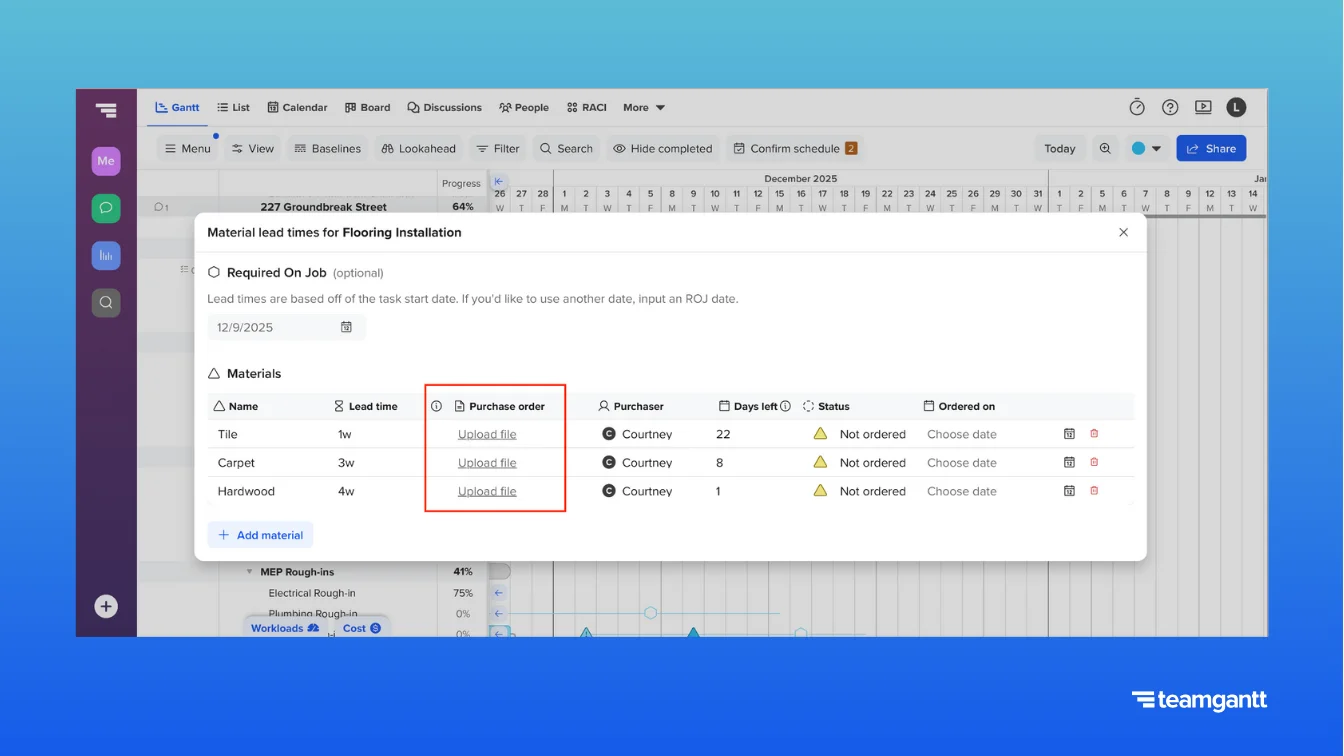

Upload the purchase order for each material on your list. That way, everyone has easy access to the PO without having to hunt for it.

Material tracking window in TeamGantt for the “Flooring Installation” task. In the Purchase order column, each listed material—Tile, Carpet, and Hardwood—includes an “Upload file” link, allowing purchase orders to be attached directly. Other fields display lead time, purchaser name (Courtney), days left, status, and ordered date. All materials remain in “Not ordered” status.

Tip

Want to attach vendor quotes or submittals too? Upload those files to the install task to keep everything connected but organized.

9. Filter your schedule by order urgency

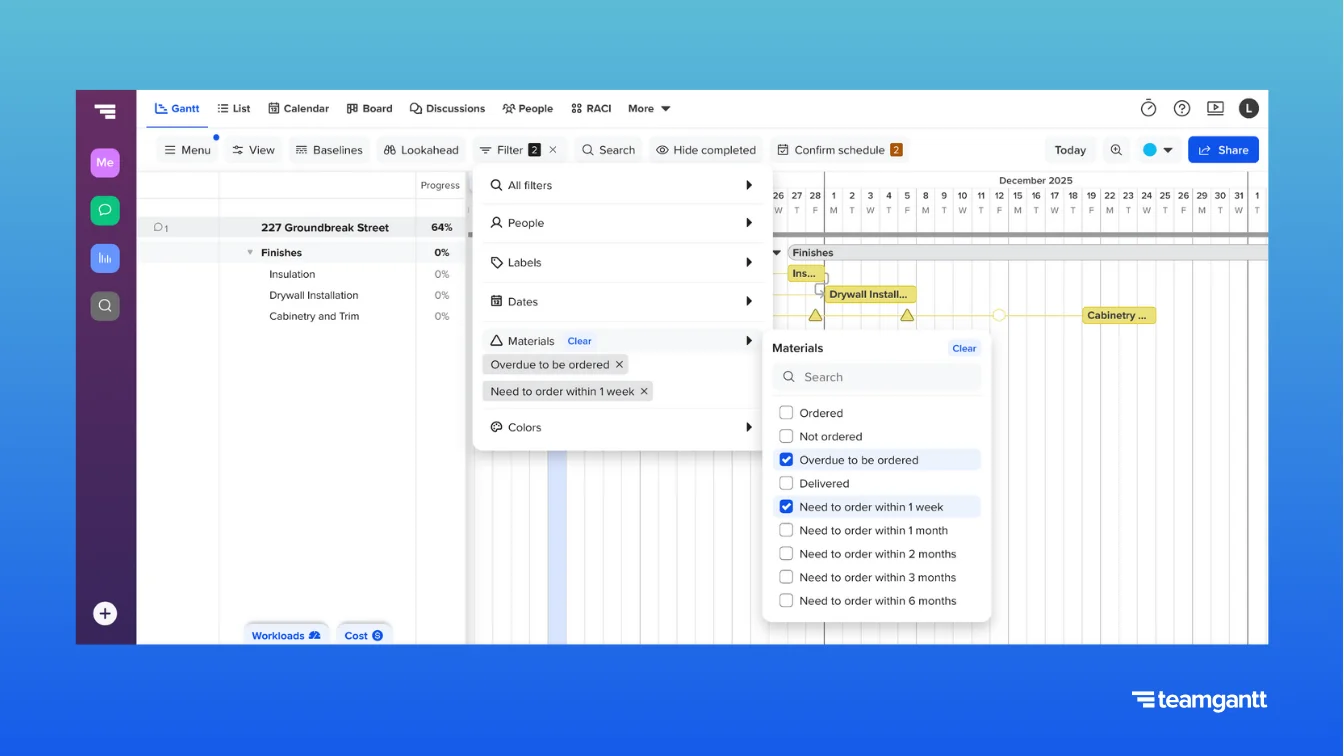

Use the Needs to order within 1 week filter to quickly review what’s due soon. You can also filter by Overdue to be ordered to see what’s behind. It’s a great way to build a Monday review rhythm.

TeamGantt gantt chart with the filter menu open, showing selected material filters: “Overdue to be ordered” and “Need to order within 1 week.” The Materials filter dropdown displays additional options such as “Ordered,” “Not ordered,” “Delivered,” and other future lead time ranges. The timeline shows yellow triangle icons marking materials that match the selected filters.

10. Let dates adjust automatically

If the install task shifts, the ROJ and order deadline update automatically. You’ll see a notification confirming the change.

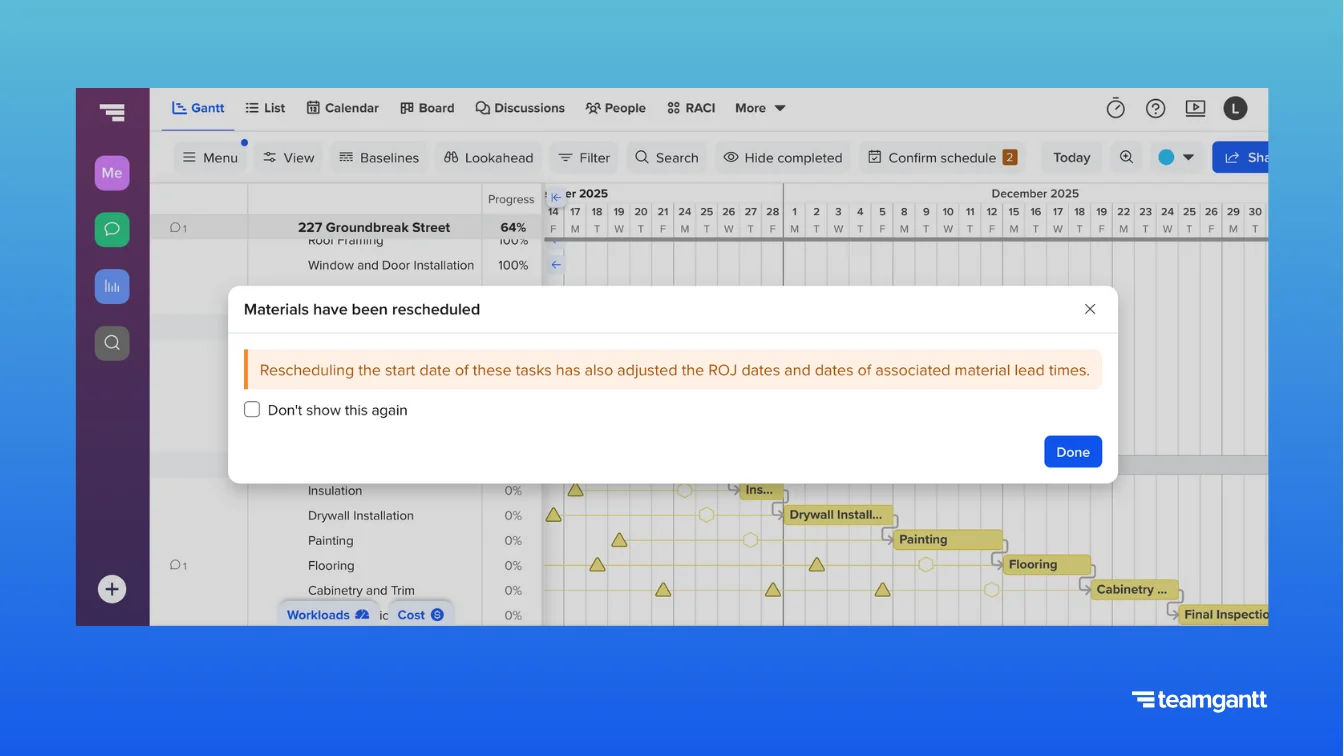

TeamGantt Gantt chart displaying a pop-up message titled “Materials have been rescheduled.” The notification reads: “Rescheduling the start date of these tasks has also adjusted the ROJ dates and dates of associated material lead times.” A blue Done button appears in the bottom right of the message, with a checkbox labeled “Don’t show this again” below the text.

What builders see when they stop missing material orders

When construction teams move from disconnected tools to tracking long-lead items in the schedule, the shift is a game-changer. Stress fades. Confidence takes over.

Before using TeamGantt After switching to TeamGantt
Materials tracked in disconnected spreadsheets Everything tracked inside the schedule
Missed orders every few jobs No missed orders in months
Stressful Mondays trying to figure out what’s falling behind Weekly ROJ review filters shared with the team

What’s next: Procurement workflows

Right now, you can track material lead times, set ROJ dates, and assign procurement owners directly in your TeamGantt. But we kept hearing the same question:

"What happens after I place the order?"

Builders told us they wanted a way to track every step of the procurement process—from submittals to delivery—in one place. And not just for one project at a time.

So we’re building a new procurement workflow that gives you a custom Kanban board with every material from every active project in a single view.

You’ll be able to:

  • Move materials through stages like Submittal Sent, Approved, Ordered, In Transit, and Delivered
  • Track vendor info, PO numbers, and delivery confirmations
  • Attach documents or notes at each stage
  • See what’s at risk across your whole portfolio, without bouncing between spreadsheets or emails

If something gets delayed or rejected, the schedule can automatically adjust any dependent tasks so you catch problems early.

The goal is simple: Make the entire procurement process visible, accountable, and connected to your timeline—across every job.

We’re testing it with a small group of customers now, and the early feedback has been phenomenal. If you want to be part of the beta when it launches later this year, let us know.

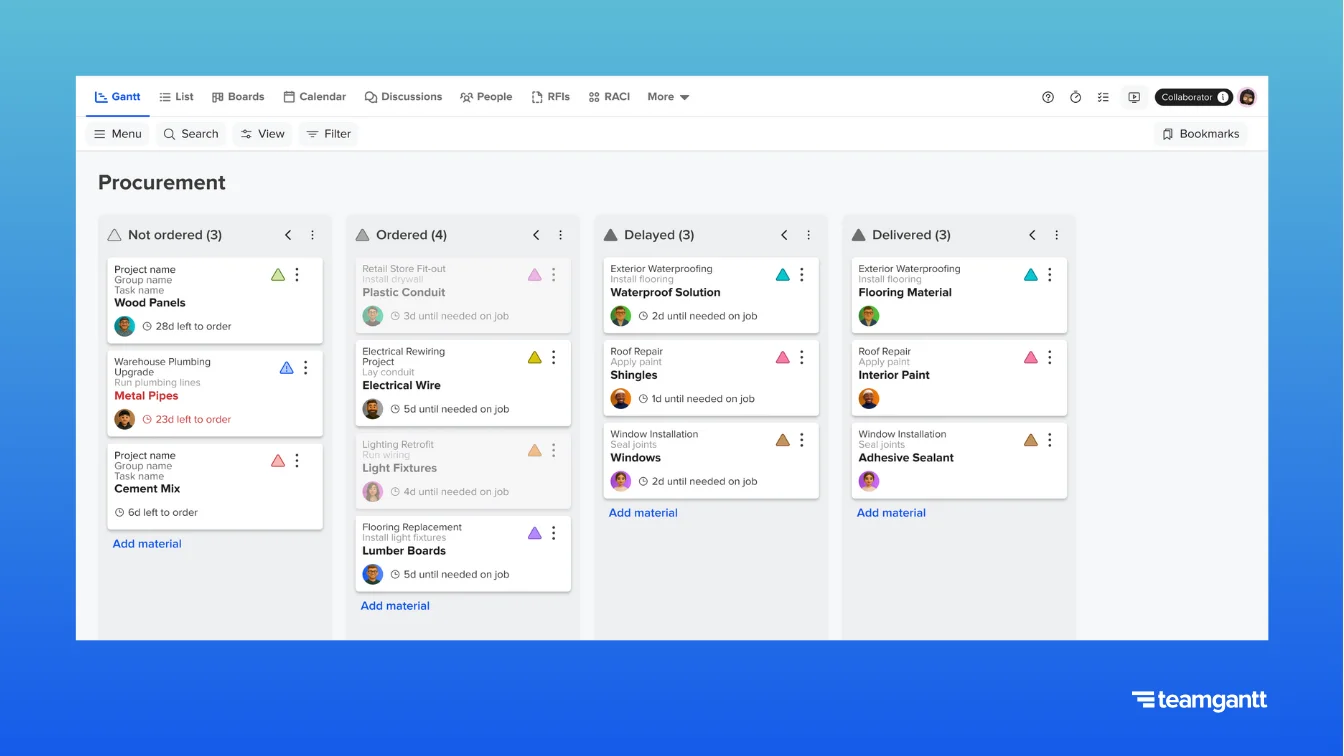

TeamGantt interface showing a preview of the upcoming procurement Kanban board feature. The board is divided into four columns: Not ordered, Ordered, Delayed, and Delivered. Each column contains cards representing materials from different projects, with task names like “Wood Panels,” “Cement Mix,” and “Electrical Wire.” Cards display metadata such as days left to order, project and task names, color-coded triangle icons indicating status, and small team member avatars. A “Materials” filter and view options are visible in the top navigation bar.
Early preview of TeamGantt’s upcoming procurement workflow, which will let you manage materials across all projects in one Kanban-style board.

Final thought: Your schedule should protect you

You can’t control tariffs, vendor shortages, or lead time inflation. But you can control how well your team anticipates procurement risk.

When procurement lives inside the schedule, everyone can see the risk—and act early.

And when you do that consistently? Materials stop being a headache. They start becoming your competitive edge.

Ready to see it in action?

You don’t have to fight procurement fires every week.

When your schedule tracks what’s at risk—and when to act—you stay ahead of delays and build stronger trust with your team and your clients.

Book a free demo and see how TeamGantt’s Construction Edition can help you stay ahead of material delays.

Frequently asked questions

Still have questions about how it all works? Here are quick answers to some of the most common ones.

What is a long-lead item in construction?

A long-lead item is any material or product that takes a significant amount of time to procure—typically 4 weeks or more. Common examples include custom windows, HVAC units, structural steel, and imported finishes.

What does ROJ mean in construction?

ROJ stands for Required on Job. It’s the latest possible date a material must arrive on the jobsite to avoid delaying installation.

How do I calculate a material’s order date?

Use this formula to calculate a material’s order date: Order Date = ROJ Date – Lead Time. For example, if your ROJ date is September 15 and the lead time is 6 weeks, your order deadline is August 4.

What’s the best way to track long-lead materials?

The most effective method is to track them inside your construction schedule—alongside the install task. This keeps deadlines aligned and visible to the full team, especially when install dates shift.

Can I automate long-lead tracking in TeamGantt?

Yes. TeamGantt lets you set ROJ dates, enter lead times, assign purchasers, and track status—all tied to your schedule. If the install date changes, your ROJ and order dates update automatically.
