How to Build a Construction Schedule: Free Excel & Gantt Chart Templates

L

Laura LaPrad• Published Jul 16, 2026 • Updated Oct 22, 2026

Construction scheduling is the process of planning the order, timing, crews, and materials for every task on a build. It’s how you turn a scope of work into dates your crews and subs can count on.

If you've ever had a crew show up before materials were delivered—or waited on an inspection no one realized needed to be scheduled—you know why this matters. A good schedule keeps people aligned, reduces surprises, and helps you catch issues before they turn into delays you can't afford.

What is a construction schedule?

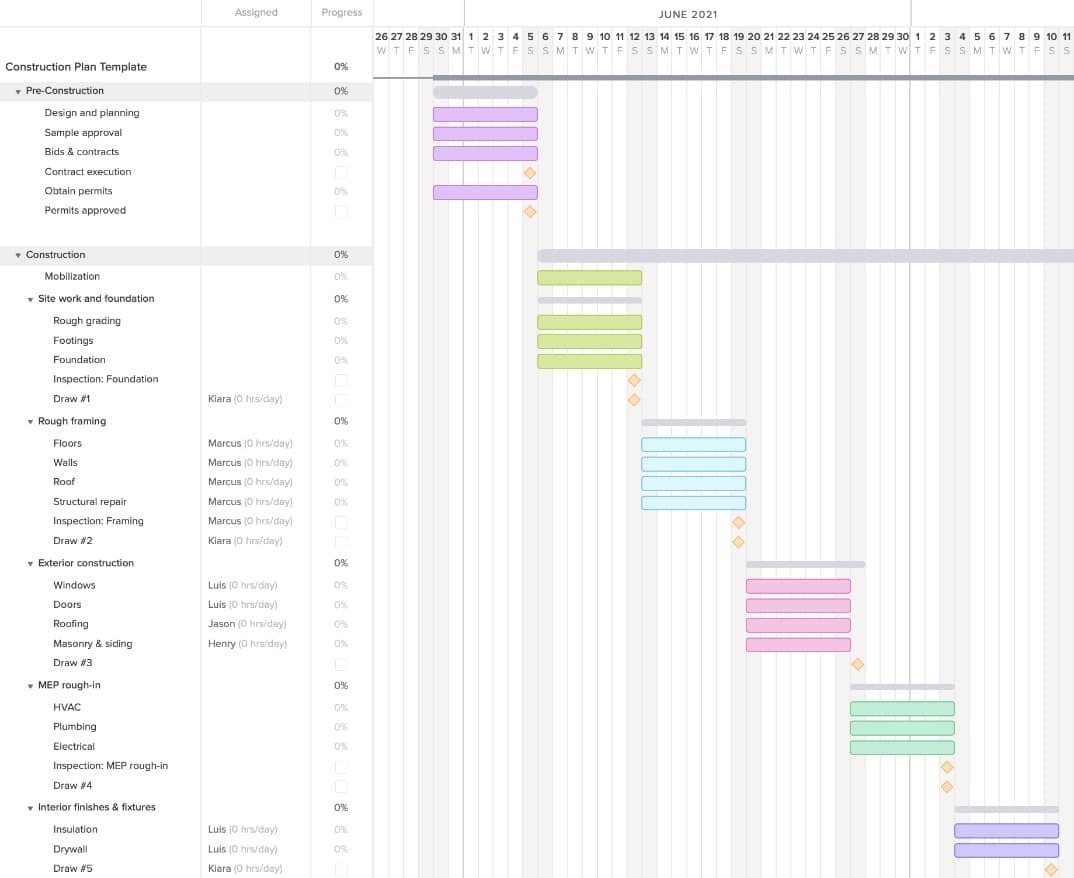

A construction schedule is a timeline that shows when and how your project will be built. It outlines each major task, the order the work needs to follow, and the expected timing for every phase, so your team has a shared view of the project from kickoff to closeout.

Building the schedule is only the start. Construction scheduling is the ongoing work of keeping that plan current as the job moves.

Several people work with the schedule, each in a different way:

  • The construction project manager or builder creates the schedule and sets the sequence.

  • The superintendent runs it in the field and reports what actually happened.

  • Subcontractors confirm the dates they're needed on site.

  • Clients follow the milestones that matter to them, like the framing walk-through or final inspection.

Each of them needs the latest version, so treat scheduling as a weekly loop: plan, share, confirm with your subs, and update.

What a construction schedule should include

A construction schedule doesn't have to be complicated, but it does need to be complete. Here are the elements that help you build a schedule that's reliable, flexible, and easy for your team to follow.

A complete task list

A complete task list shows the full scope of work.

Start by breaking the project into phases and outlining the major work inside each one. Preconstruction, site prep, rough-in, framing, finishes, inspections—getting everything in one place makes the rest of the planning process much easier.

A realistic project timeline

A realistic timeline reflects how long the work will actually take.

Build your timeline around honest durations. Use what you know from past projects, current crew capacity, and any predictable constraints. A realistic schedule sets expectations you can actually meet and avoids unnecessary reshuffling later.

Task sequencing and dependencies

Task sequencing shows the natural order of the build.

Your schedule should show which tasks depend on others and where work can overlap. Clear sequencing keeps crews from getting in each other's way and ensures tasks are ready when the next trade arrives on site.

Key project milestones

Milestones mark key checkpoints in the project.

Inspections, major approvals, client walk-throughs, and phase completions make it easier to track progress and communicate with stakeholders.

Resource and subcontractor assignments

Every task needs a clear owner to keep work moving.

Assigning responsibilities early helps your team prepare, reduces bottlenecks, and gives subcontractors enough lead time to plan their crews.

Materials and procurement considerations

Materials can affect your timeline as much as labor.

Add tasks or notes for ordering, tracking, and receiving materials—especially anything that requires longer lead times—to make sure work doesn't slow down once construction is underway.

Visibility into the critical sequence of work

The critical path shows which tasks control project duration.

Some tasks drive the overall project duration and leave little room for delay. Knowing which tasks are critical shows you where setbacks will hit hardest and where your team needs to stay focused as the job moves forward.

Supporting documents and information

Schedules work better when key documents are easy to access.

Attach drawings, permits, change orders, and other details so teams have what they need right when they need it.

Room for adjustments and short-term planning

Construction schedules must adapt as field conditions change.

Build in space for updates and create short-term (commonly 3–6 week) lookahead views so crews always know what's coming up next.

Why use a Gantt chart for construction scheduling

A Gantt chart puts every task on a visual timeline, so you can see what’s scheduled now and what’s coming next.

On a build where one late trade can hold up three others, that view is what keeps the job moving.

See the full sequence of work

When you see the full flow of work, you can spot trouble early.

A Gantt chart shows how tasks connect, where phases overlap, and which steps depend on others. You can see how a delay in one spot ripples through the rest of the timeline.

Improve communication with trades and crews

Clear timelines help subcontractors plan ahead.

Each trade can see when they're needed and what has to be finished before they start. That keeps crews aligned and saves wasted trips to the jobsite.

Adjust the plan as field conditions change

Gantt charts make schedule changes easier to manage.

You can shift tasks, update dates, and revise the timeline without rebuilding the schedule from scratch, so everyone keeps working from the same plan.

Construction scheduling methods

No single scheduling method covers everything a construction job needs. A Gantt chart gives you the full picture, the critical path tells you which tasks can't slip, and a lookahead keeps the next few weeks on track. Combine the three, and you can see the whole job, protect your finish date, and keep crews ready for what's next.

Here's how each approach works and when it earns a place on your job.

Gantt chart scheduling

Gantt chart scheduling plots each task as a bar on a timeline, with links between tasks that depend on each other. It's the clearest format for showing trades and clients what happens when. Use it as the master schedule everyone reads from, then layer other methods on top when the job calls for them.

Critical path method (CPM)

The critical path method (CPM) finds the longest chain of dependent tasks, and that chain sets your finish date. It's a waterfall-style approach: you plan the full sequence up front, then manage the job against it.

Float is the room a task has before it delays the finish date. Tasks on the critical path have zero float, so any slip there moves the end of the project.

On a kitchen remodel, the chain might run framing, rough-in, rough-in inspection, insulation, and then drywall. A late rough-in inspection pushes back every task behind it. A late tile delivery may have a few days of float, so it can wait while you deal with the inspection.

Lookahead schedules and the Last Planner System

A lookahead schedule is a short window pulled from the master schedule—commonly 3 to 6 weeks, or longer when long-lead items are in play. It zooms in on the next few weeks so you can confirm crews, materials, inspections, and site readiness before work starts.

The Last Planner System adds a weekly layer on top of the lookahead. The trade foremen who do the work commit to what they'll finish next week, and the team reviews what actually got done.

On a small job, a weekly sub meeting built around the lookahead is a practical way to start. Ask each trade what they'll finish, then check those commitments the following week.

Line of balance and location-based scheduling

Line of balance schedules repetitive work by location, so each crew moves from unit to unit at a steady pace. It fits townhome rows and multifamily floors, where framing, rough-in, and drywall repeat in every unit.

Construction schedule levels

Construction schedules come in levels of detail, from a one-page summary down to the daily tasks crews work from. Larger projects number these levels (Level 1, Level 2, and so on), and three levels usually cover a residential job:

  • Summary schedule: phases and key milestones for owners and clients

  • Master schedule: every task, dependency, and trade for the project manager

  • Lookahead and weekly work plan: the next few weeks, broken into tasks for crews and subs

Build the summary and lookahead from the master schedule so they never disagree. When a date changes, update the master first, then share the new lookahead.

How to choose an approach for your job

Match the method to the size and shape of the job:

  • Small remodel: A Gantt chart with dependencies between trades is usually enough.

  • Multi-trade new build: Add critical path tracking and a weekly lookahead with your subs.

  • Repetitive units: Consider line of balance for framing, rough-in, and finish crews.

A lean residential team can usually skip the program evaluation and review technique (PERT), which uses three-point estimates for each task. Start with a Gantt chart and dependencies, then add a method when a specific problem shows up, like two trades stacked on the same week.

How to create a construction schedule (step-by-step)

The goal of construction scheduling isn't to create a perfect plan on the first pass. It's to build a clear, realistic structure you can adapt as things change.

Here's a process you can use for any residential or commercial build. Prefer to watch? This video walks through the basics.

Step 1: List all tasks, materials, and milestones

Start with a clear list so you're building from the full scope.

Break the project into phases and list the major tasks for each one. Include everything you know needs to happen—preconstruction activities, site prep, rough-in work, finishes, inspections, client walk-throughs, and closeout items.

If you already know certain materials will require special ordering or longer lead times, jot those down too.

To keep the list manageable, build a work breakdown structure (WBS). Split the scope into phases, then break each phase into tasks a single trade can own. Framing, for example, might break into walls, roof trusses, sheathing, and the framing inspection.

Step 2: Build your timeline

Give each task a timeframe that reflects how your team actually works.

Estimate how long each task will take based on past experience, crew capacity, and seasonal considerations in your area. Then set start and end dates that reflect what's actually doable—not what you wish you could pull off.

Pull durations from three places: past jobs, quotes from your subs, and the crew size you'll actually have on site. When a sub's estimate and your own history disagree, use the longer number and revisit it after the first week of work.

Give waiting time its own tasks. Concrete cure time, inspection lead time, and permit turnaround belong on the schedule as separate tasks, so they don't hide inside "foundation" or "framing."

Step 3: Track materials alongside your tasks

Tie materials to the tasks that need them so nothing slips through the cracks.

Attach key materials directly to the tasks where they'll be installed so you can track delivery status right in line with your timeline. This keeps procurement and scheduling connected so you don't end up with crews on site waiting for materials that haven't arrived yet.

In TeamGantt Builder Edition, hover over a task bar and click the Track Material icon. Set the Required on Job (ROJ) date, then add each material with its lead time, purchaser, PO, and status.

Materials show as triangles on the task's row, and the ROJ date shows as a hexagon. A shaded triangle means the item is ordered, and an exclamation mark shows an item past its order date.

When the windows for a remodel show an exclamation mark, call the supplier that day and confirm delivery before you book the installer. The Procurement tracker shows materials across all your active jobs, so cabinets on one project and windows on another sit in the same view.

Step 4: Add task sequencing and dependencies

Show the real order of work so your schedule matches the jobsite.

Most tasks depend on something else being completed first, while others can run in parallel. Your schedule should reflect those connections clearly so crews know when work is ready for them.

If one task has to finish before another can start, connect them. If two tasks can overlap, show that too. The more accurately your schedule mirrors the real flow of work, the fewer surprises you'll deal with on-site.

In TeamGantt, link dependent tasks so you can see what a date change affects before you call the next trade. Add lag between linked tasks for cure or dry time, like the gap between drywall finishing and paint.

Once tasks are linked, the Critical path toggle highlights the critical path while other tasks dim, or filters the view to only those tasks. Turn it on before your weekly update so you can see which slip would move the finish date.

Step 5: Assign subcontractors, crews, and resources

Assign each task to the right trade so everyone knows what they own.

Add names for each trade or crew to the schedule and make sure the workload isn't stacked in a way that overbooks people or creates bottlenecks.

This is also a good time to note any equipment or special resources you'll need—rental gear, lifts, tools, or deliveries. A well-assigned schedule helps everyone plan ahead and reduces downtime once the project is underway.

In TeamGantt, the Workloads tab shows a daily heat map of tasks or hours per person, for one project or across all your active projects. Darker cells show where a crew is stacked, so you can see an overbooked trade before you lock dates. When two jobs share one drywall crew, check the heat map before you promise either client a start date.

Step 6: Track progress and adjust as the project evolves

Update the schedule often so your plan stays aligned with field conditions.

Things will shift along the way—a delivery might get pushed back, an inspection might run long, or a crew might finish early. Your schedule should adapt to what's actually happening in the field.

Update your plan regularly. Weekly works well for most teams. Look for anything that's running ahead or behind, and shift dates, durations, or task sequences as needed.

Save a baseline in TeamGantt before work starts. A schedule baseline is a snapshot of your original plan. During each weekly update, the gray bar under each task and the Baselines column show how many days ahead or behind each task is.

When drywall shows several days behind, check whether it sits on the critical path before you rearrange other trades.

Construction Gantt chart best practices

Once you've built the basic timeline, a few small adjustments can make your schedule much easier to read and maintain—especially when you're coordinating multiple trades or phases at once.

Organize tasks into clear phases

Grouping related work makes your timeline easier to manage.

Break your project into logical groups—like preconstruction, site work, MEP rough-in, framing, exterior finishes, interior finishes, and closeout. Grouping tasks this way helps you see how each phase is progressing and makes it easier to adjust several tasks at once when plans shift.

During the MEP rough-in phase, you might create subgroups for plumbing, electrical, and HVAC work so you can see what each trade is responsible for and how their timelines overlap.

Use color coding to improve clarity

Color coding helps you understand the schedule at a glance.

Color coding makes your schedule easier to read at a glance. Assign colors by trade, phase, or priority level, so you can see who’s doing what and where the work is concentrated. That saves back-and-forth when you’re coordinating subs or giving clients a quick progress update.

Review a lookahead in your weekly sub meeting

Lookahead planning helps you spot issues before they affect the main schedule.

In Builder Edition, a Lookahead lets you pick a 2–6 week window and a start date, and only the tasks in that window show. Pull it up in your weekly sub meeting and walk each trade through what's next: materials on site, inspections booked, and where each crew starts.

Construction schedule templates

A good construction schedule doesn't have to start from a blank page. Templates give you a solid foundation so you can focus your time on planning the work—not formatting a document.

Many small builders start their schedules in a spreadsheet because it's familiar and easy to set up. Once you're coordinating multiple trades, a more flexible, visual template can save you time and rework.

Excel construction schedule template

Excel makes it easy to sketch out an early plan.

If you're used to working in spreadsheets, an Excel schedule is a simple way to lay out your phases and list tasks in order. It's a good fit for a rough plan or a small residential project.

Once the schedule starts shifting, though, each change means manual edits, and shared files can drift out of sync. See why TeamGantt is a good Excel alternative once schedules start moving fast.

Online construction schedule template (Gantt chart)

Online Gantt chart templates make scheduling easier to manage.

When you're working with several trades or a schedule that evolves as the project moves forward, an online Gantt chart template gives you more flexibility. You build the timeline visually, adjust dates with drag-and-drop, and see how changes affect the rest of the plan.

Everyone sees the same schedule in real time, with tasks, documents, and notes in one place.

Use a construction schedule template that fits your workflow

Choose the template that fits the way you plan:

If you start in Excel, move the plan into the online template once a second trade needs to see your dates.

Why your construction schedule should sit at the center of your workflow

A schedule only helps if everyone uses it. Here’s what it takes to put it at the center of the job.

Keep everyone working from the same plan

A central schedule gives every team the same view of the work.

When your schedule anchors the project, there's no guessing which version is correct. Discussions, updates, and shared notes tie back to the same timeline, so you spend less time chasing people down and more time keeping the project moving.

Reduce manual updates and double work

Connecting your tools to the schedule cuts down on duplicate effort.

Every tool that keeps its own copy of the dates is one more place for them to go stale. If you run Procore, TeamGantt pushes your schedule to Procore's Schedule tab. Once the integration is set up, updates flow automatically from TeamGantt to Procore every 10 minutes, so both tools show the current plan. Here's how the Procore integration works.

Give field teams the visibility they need

Easy access to the schedule helps crews stay productive.

When crews can check the schedule directly—on their phone, tablet, or wherever they work—they're better prepared for the day. Clear access to the plan reduces on-site confusion and helps the field stay on track.

In TeamGantt, crews can check their tasks in the mobile app, subs can follow a live, view-only link without creating an account, and the client portal lets you choose how much of the schedule clients see.

If your team still treats the schedule as office paperwork, start with these scheduling myths that trip construction teams up.

Managing delays, changes, and closeout

Even with a solid plan, construction rarely goes exactly as scheduled. Deliveries slip, inspections run long, and weather costs you days.

A good construction schedule doesn't eliminate these issues, but it does make them much easier to manage. Here's how to keep your project moving when plans shift—and how to wrap things up smoothly once you reach the finish line.

Adjust the plan when field conditions change

Updating the schedule early prevents small issues from growing.

When something shifts on the jobsite, update the schedule right away. Even small changes—like moving a start date by a day or two—can affect the tasks around it. Adjusting early keeps your team aligned and prevents common problems from snowballing into budget issues.

Revisit your task sequencing to keep work flowing

A flexible sequence gives you options when delays happen.

If a key task gets delayed, look at how it affects the work that follows. You may need to shift dependencies, rearrange overlapping tasks, or move another crew forward to keep the project moving. A flexible schedule gives you choices instead of forcing a total reschedule.

Communicate updates clearly with your team

Changes only work when everyone knows about them.

Share updates with subcontractors and field crews as soon as you make them so the right people show up at the right time. Clear communication reduces wasted trips and keeps work progressing even when plans shift.

In Builder Edition, the number beside the Confirm schedule button shows how many tasks have new dates. Request confirmation, and subs confirm or decline from an email or text link without a TeamGantt login. Their responses show in the Confirmation column.

If your drywall sub declines the new start date, you know before the truck rolls and can line up another crew or shift the sequence.

Use punch lists to finish the project strong

Punch-list tasks stay on track when they live inside the schedule.

Toward the end of the project, punch-list items tend to stack up quickly. Add them directly to your schedule so you can assign responsibilities, track progress, and make sure nothing slips through the cracks.

Document schedule changes with clear records

Clear documentation protects the project and the team.

Whenever a change affects scope, timing, or cost, document it so everyone understands what shifted and why. A clear record keeps the project moving and protects you from misunderstandings later.

Collect closeout documents in one place

Centralizing closeout documents makes turnover smoother.

Closeout requires a lot of paperwork—from inspections and warranties to manuals and approvals. Keeping these documents with your schedule makes them easier to find when you need them and helps owners feel confident the job was completed properly.

Review the project and capture what you learned

A quick review helps every schedule get better than the last.

Once the final walkthrough is complete, look back at what went well and what you'd adjust next time. The more you learn from each project, the better your schedules—and your builds—become.

Before your next job kicks off, use our guide to preventing construction delays to check the new schedule against the most common causes of slippage.

Choosing the right construction scheduling tool

Your schedule can live in a spreadsheet or a shared Gantt chart. The right choice depends on the size of your project, how often dates change, and how many people need access.

Construction scheduling comparison

Excel schedule

Online Gantt chart schedule

Setup

Familiar and quick for a rough outline

Visual timeline built with drag-and-drop

Dependencies

Updated by hand when dates move

Linked tasks show what a date change affects

Staying current

Each change means manual edits, and copies can drift apart

One shared schedule everyone works from

Field access

Hard to read and update on a phone

Mobile app for crews, view-only links for subs and clients

Documents

Stored separately from the schedule

Drawings, notes, and permits attached to tasks

Best for

Small, simple jobs and early planning

Multi-trade builds and schedules that change often

If more than one trade needs your dates every week, the online Gantt chart column is usually the better fit.

Frequently asked questions

What is construction scheduling?

Construction scheduling is the process of planning the order, timing, crews, and materials for every task on a build. The result is a construction schedule the whole team works from and updates each week.

Why is a construction schedule important?

A construction schedule keeps crews, subs, and clients working from the same plan. It shows how the work fits together, what's coming next, and which delays would move your finish date.

What are the main construction scheduling methods?

The main methods are Gantt chart scheduling, the critical path method (CPM), lookahead scheduling with the Last Planner System, and line of balance. Most residential jobs combine the first three: a Gantt chart for the full picture, the critical path for the tasks that can't slip, and a lookahead for the next few weeks.

What are the different levels of a construction schedule?

Schedule levels range from a summary of phases and milestones down to the detailed tasks crews work from each day. Three levels cover a typical residential job well: a client summary, a master schedule for the project manager, and a lookahead for crews.

How detailed should a construction schedule be?

Your schedule should be detailed enough to guide the work but not so granular that it becomes hard to maintain. Focus on major phases, key tasks, and important milestones. As long as crews understand what's expected and when, the schedule is doing its job.

What's the best format for a construction schedule?

Spreadsheets work for simple jobs. Gantt charts make it easier to see how work flows, where tasks overlap, and how to adjust when plans change.

What is a construction schedule template?

A construction schedule template is a ready-made schedule with phases, tasks, and dependencies already laid out, so you start by editing instead of building from scratch. TeamGantt's free construction master schedule template works for anything from a small renovation to a full new build.

How often should a construction schedule be updated?

Update your schedule at least once a week, and anytime something shifts: crew availability, material deliveries, inspections, or scope. Regular updates keep the timeline accurate and help you catch delays early.

Who needs access to the construction schedule during a project?

Project managers, superintendents, and subcontractors need access to coordinate their work. Clients usually need a simpler view. In TeamGantt, the client portal lets you share just the groups or milestones clients care about, or the entire project, and subs can follow a view-only link without an account.

Build a schedule your crews can count on

Use our free construction master schedule, or let AI draft one from your job details.
