A video production schedule is a timeline of every task and deadline in a video project. It puts pre-production, production, and post-production in order, so your cast, crew, and reviewers know what happens when. This guide covers each phase, realistic durations, and how to keep the plan current once dates start to move.

Prefer to watch? See how to plan a video production in TeamGantt.

What is a video production schedule?

A video production schedule is the master timeline for a video project, covering every task from the first script draft to launch day. It keeps cast, crew, props, and equipment where they need to be, and gives stakeholders clear dates for every approval. It works for any type of video project, from TV and film to corporate marketing and advertising, and it’s a useful tool for communicating with stakeholders.

Video production schedule vs. shooting schedule

A production schedule covers the whole project, while a shooting schedule zooms in on the filming days. Most productions need both, and the shooting schedule fits inside the production phase of the larger schedule.

Video production schedule

Shooting schedule

What it covers

Every task, from concept and script through edits and approval

Filming days only

Level of detail

Phases, tasks, owners, and milestones

Scenes, call times, locations, and breaks

Who uses it

Producers, crew leads, and stakeholders

Cast and crew on set

How often it changes

Updated weekly as work moves

Set before each shoot day, adjusted on set

How to create your video production schedule

The video production process consists of 3 key phases: pre-production, production, and post-production. Here’s a quick look at what you can expect at each stage so you have a starting point for scheduling your own video production tasks.

Phase 1: Pre-production

Pre-production is all about creative development and logistical planning. The time you put in here pays off on shoot day and at approval. Be sure to account for these pre-production steps in your schedule.

1. Develop your video concept

Every video you produce, whether it’s a series, a documentary, or another piece of content, should have a goal. So before you put pen to paper, think about what you want to accomplish.

With clear goals in mind, you can form a solid creative concept that’s centered around your audience and objectives. Work closely with stakeholders to get their input and buy-in early in the process so nobody’s surprised by the direction later.

These questions are a great place to start:

  • Who do you want to reach?

  • What action do you want your audience to take?

  • What’s the message you want to convey?

  • How will you measure success?

A creative brief can be a helpful tool for documenting goals for your video project, as well as other key details, like scope, requirements, and tone.

Once stakeholders agree on the answers, add a concept sign-off milestone before scripting starts. That keeps writing time focused on an approved idea and gives stakeholders a clear date to weigh in.

2. Write the script

Next, carve out time in your video project production schedule to move into script writing. Your script should be conversational, concise, and clearly formatted with characters, scenes, and stage actions noted.

Practice reading your script out loud to be sure the dialogue flows naturally and fits within the video’s intended time frame.

Filming a documentary? Prepare for interviews by drafting a list of questions and sharing them with guests or featured experts ahead of time. This helps ensure conversations stay on track so you don’t miss important points of discussion.

Give script revisions their own task after the first draft, and link it to the storyboard task with a dependency. That way, if revisions run long, you’ll see the storyboard waiting on them before you book an artist.

3. Storyboard and outline your shots

Sketching your storyboards helps you identify all the different shots that go into each scene and ultimately weed out shots that won’t work. Once your storyboards are solid, outline a shot list with specific details on who and what each shot needs to capture.

The shot list feeds your shooting schedule, so give it its own task, owner, and due date.

4. Plan the logistics

Next, settle the logistics so shoot day runs smoothly. This is a great time to bring budget into the equation so you know how much money you can spend on talent, equipment, and locations.

Consider the following tasks as you plan and prepare for your video shoot:

  • Cast talent (or conduct interview outreach for documentary productions)

  • Scout location(s) and obtain any necessary permits

  • Rent or purchase equipment

  • Meet with all cast and crew members

  • Develop the shot list and shooting schedule (e.g., when scenes will be shot, where people need to be at certain times, when to break for the day)

Permits and location holds often have the longest lead time, so schedule them first. Once locations are confirmed, set the shoot date as a milestone.

Phase 2: Production

The production phase is where “Lights, camera, action!” happens. Expect these steps on set:

  1. Studio and location setup. Set up your studio or location so your staging, lighting, and audio are just right.

  2. Scene blocking. Once your cast arrives, block each scene to map how the actors move in relation to the camera.

  3. Rehearsal. Rehearse with your actors, and make any necessary adjustments.

  4. Roll camera. Now you’re ready to film. Capture the action, and be sure to get plenty of B-roll footage.

Schedule each shoot day as its own task so a slip stays visible, and mark the wrap as a milestone. If a shoot day moves, your dependencies show which edit tasks it affects. That gives you time to rebook the editor while the review dates are still safe.

Phase 3: Post-production

Post-production is where raw footage becomes a finished video, and it usually takes longer than the shoot itself. Plan for three steps: the edit, stakeholder review, and launch.

1. Edit your raw footage into the final product

This is where the bulk of post-production work happens. Key tasks in this step include:

  • Ingest and organize footage

  • Create assembly cuts

  • Do color correction and grading

  • Score music, and edit and mix sound

  • Add titles, credits, graphics, and visual effects

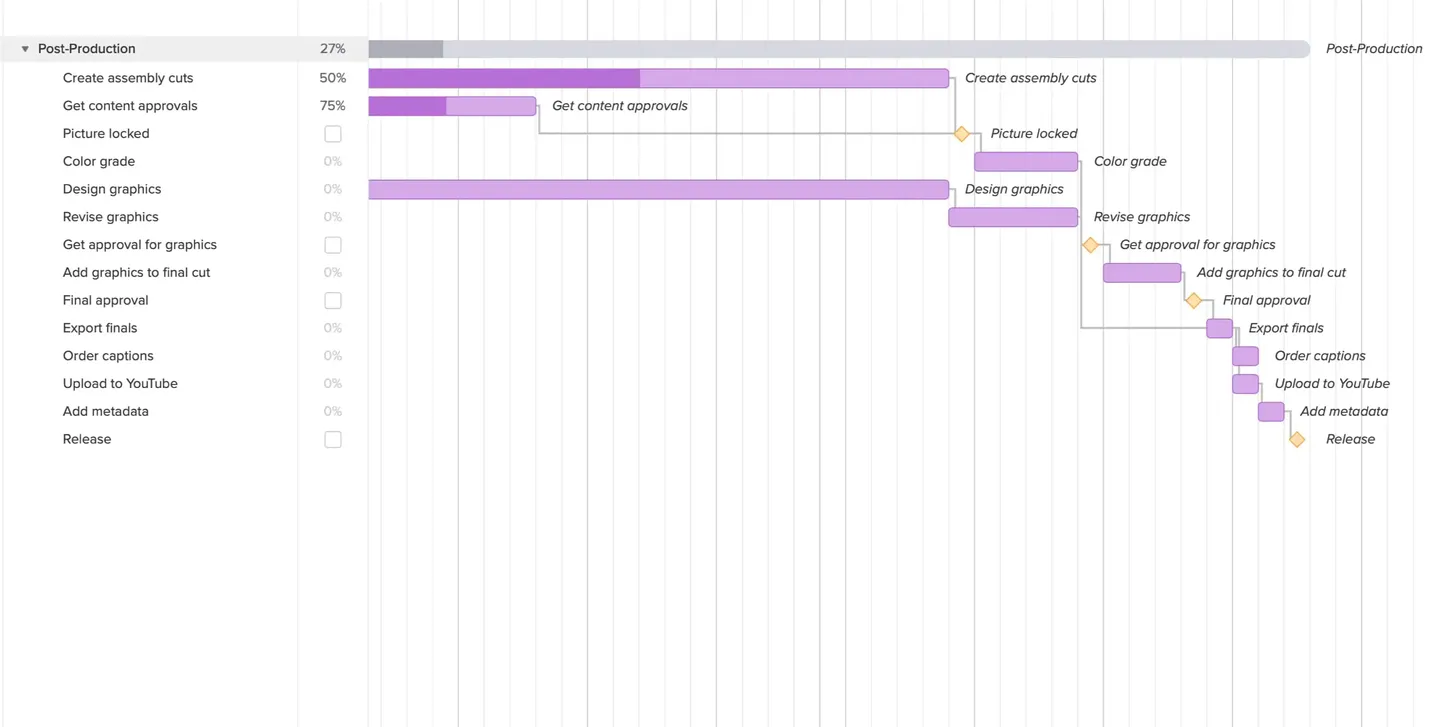

Add each of these steps to your schedule as a separate task. If the whole edit sits on one long taskbar, nobody can tell whether color is done or sound is still in progress. Separate tasks show exactly where the cut stands.

2. Get stakeholder review and approval

Be sure to get approval from your stakeholders before optimizing and exporting the final cut.

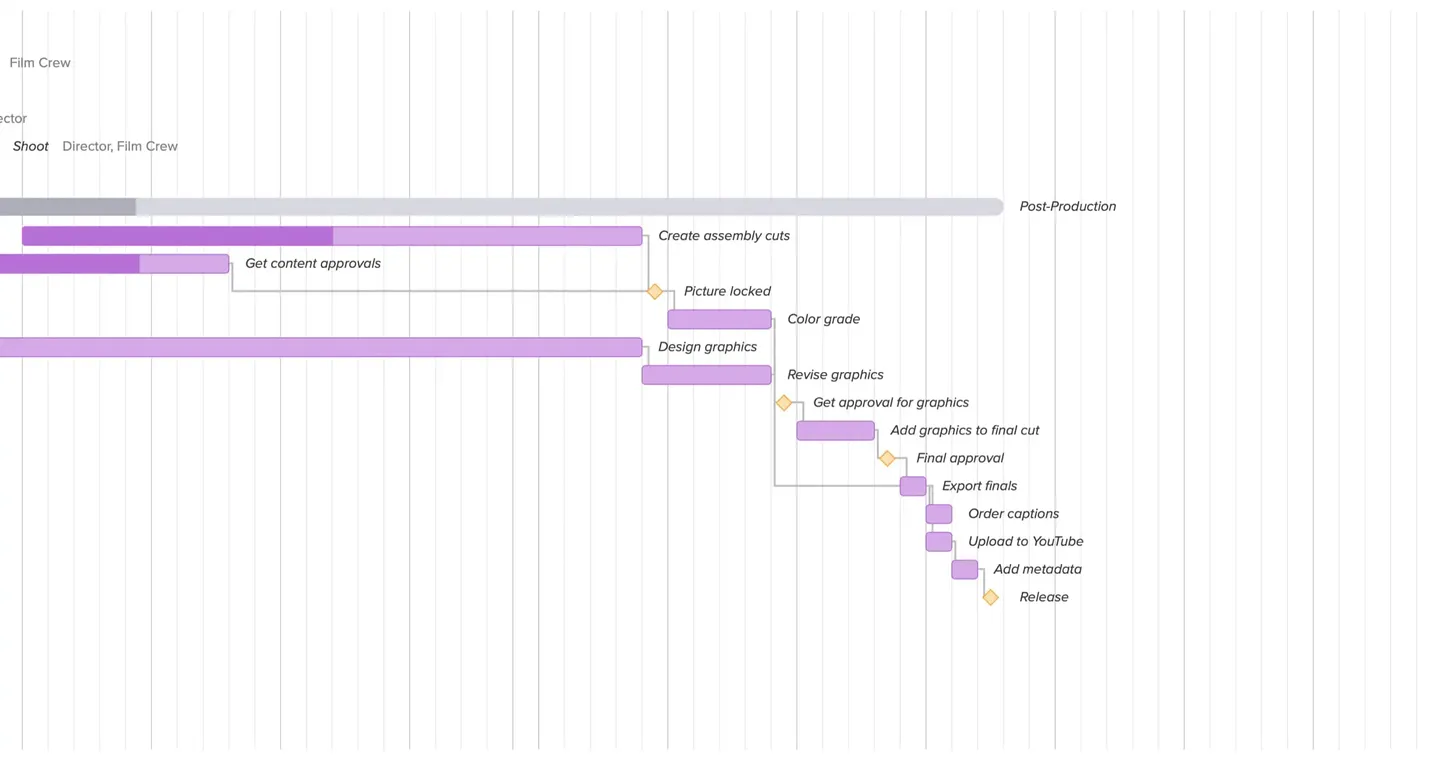

Decide up front how many review rounds you’ll allow, and add a milestone for final approval. Keep feedback in each task’s discussion with the cut attached as a file, so the editor works from one set of notes.

Then share a live, view-only link to the timeline. Stakeholders can check the approval date themselves, and you’ll field fewer status questions.

3. Post and promote your video

Once you get the green light to launch, you’re ready to go live and share your video across your digital marketing channels.

Our digital marketing campaign guide can help you map out a promotional strategy for your new video.

Add the publish date to your marketing calendar so promotion lines up with launch day.

Planning a video series

A video series uses the same three phases, repeated for each episode. The difference is shared resources: the same crew, studio, and promo calendar serve every episode, so plan them once across the whole run.

Build each episode as a repeated task group with the same phases, so every episode follows the same sequence. Put each episode’s publish date on its own milestone. If a later episode slips, drag its tasks to new dates and leave earlier episodes where they are.

How long does video production take?

How long a video takes depends mostly on its scale. A quick social clip can go from idea to post in a few days, while a polished brand video can take a couple of months. Here’s how that range usually breaks down:

Video type

Example

Typical timeline

Quick social clip

A 30-second tip filmed on a phone in one take, with light edits

A few days to a week

Explainer or product demo

A 2-minute walkthrough shot at one location, with one or two review rounds

3–6 weeks

Brand or campaign video

A multi-location shoot with hired talent, animation, and legal review

2–3 months or more

Treat these as starting points, not rules. Each added location, reviewer, or animation sequence pushes a project toward the longer end.

On explainers and brand videos, the time usually splits like this:

  • Pre-production usually takes the largest share, because concept approval, scripting, and permits all need lead time.

  • Production is often only a few shoot days, even on bigger projects.

  • Post-production and review take the next-largest share, and review rounds drive most of it.

Build the schedule backward from your publish milestone. Place final approval first, then the review rounds, then the edit, and set shoot dates last. If a stakeholder asks to pull the publish date in, you can point to the review round it would cut and decide together.

What changes your video production timeline

These are the most common reasons a video takes longer than planned, and how to plan for each:

What changes

What it adds

How to plan for it

More locations or shoot days

Scouting, permits, travel, and another shoot day each

Schedule permits first, and give each shoot day its own task

Limited talent availability

Longer casting or interview outreach

Start outreach early, and set the shoot date after talent confirms

Animation or visual effects

Extra edit time

Give them their own tasks after the assembly cut

Extra review rounds

More time between the first cut and final approval

Set the number of review rounds up front

More stakeholders

Longer concept sign-off and review rounds

Plan one extra review round when more than a handful of people approve

Pad the tasks that depend on other people’s calendars, such as permits, talent holds, and reviews. Review rounds slip more often than shoot days. A shoot day has crew, gear, and a location booked against it, while feedback waits in someone’s inbox.

How to keep your video production schedule current

Once stakeholders approve the plan, save a baseline. A baseline is a snapshot of your approved dates, so you can compare it to actual progress when something slips.

Then run this short routine on the same day each week:

  1. Update percent complete on every active task.

  2. Check your dependencies to see what any changed date affects.

  3. Adjust the downstream tasks, starting with the next handoff.

  4. Compare the current plan to your baseline to see how far key milestones have shifted.

  5. Share the same live timeline link instead of re-sending files or screenshots.

When you share the update, call out what changed, why it changed, and which milestone it affects.

Video production schedule template

Plan your next documentary, ad, or corporate video with our video production schedule template. Add your tasks, shoot dates, and review deadlines, and try it free for 14 days.

The template opens as a Gantt chart, where you can connect dependent tasks, mark approval and publish dates with milestones, and track progress. Switch to List view for a checklist of each phase, or Calendar view to see when shoots and reviews are scheduled.

Use Board view to track post-production. Set up columns like In edit, In review, and Approved, then move each cut through them so reviewers can see what’s waiting on them.

Need a different starting point? Browse more Gantt chart templates.

What is the difference between a production schedule and a shooting schedule?

A production schedule covers every task from concept to publish, while a shooting schedule covers only the filming days. The shooting schedule sets when scenes are shot, where people need to be, and when to break.

What should a video production schedule include?

A video production schedule should include:
  • Every task across pre-production, production, and post-production, each with an owner and dates
  • Dependencies for work that has to happen in order, like the script before the storyboard
  • Milestones for concept sign-off, the shoot, final approval, and the publish date
  • Lead time for permits, locations, and talent
  • A set number of review rounds, so feedback has a clear end point

How long does it take to make a video?

It depends on scale. A quick social clip can take a few days, an explainer or product demo usually takes 3–6 weeks, and a multi-location brand video can take 2–3 months or more.

Who should own the video production schedule?

The producer or project lead should own the video production schedule. Team members update their own tasks, but one person checks the dates each week, adjusts dependencies when something moves, and decides when to add a review round. That keeps everyone working from the same plan.

Can I make a video production schedule in a spreadsheet?

Yes, for a simple shoot with a short task list. A spreadsheet can’t link tasks, though, so when a shoot day or review moves, you have to update every later date by hand. In a Gantt chart, when you drag a task to a new date, its dependent tasks move with it.

Get from script to final cut on schedule

Start with our video production template, or let AI turn your video plan into a timeline.
