What Is a RACI Chart? A Complete Guide to Roles, Responsibilities, & Examples

B

Brett Harned• Published Aug 24, 2025 • Updated Sep 29, 2026

A RACI chart is a simple matrix that clarifies who is responsible, accountable, consulted, and informed for every task in a project. It helps teams avoid confusion, streamline communication, and ensure nothing falls through the cracks.

Even a good plan stalls when nobody knows who makes the call.

Ineffective decision-making is one of the biggest reasons projects stall. A McKinsey study on decision-making highlights the impact:

  • Managers spend 37% of their time making decisions.

  • More than half of that time is wasted.

  • For Fortune 500 companies, the inefficiency adds up to 530,000 lost workdays and about $250 million in wasted labor costs each year.

This wasted effort shows why accountability matters—and why RACI charts are so effective at keeping projects on track.

In this article, we'll explain what RACI stands for and how it's used in project management. We'll also share practical examples of how to apply the RACI model to different types of projects.

What is a RACI chart?

A RACI chart is a type of responsibility assignment matrix (RAM) used in project management to define roles across 4 categories:

  • Responsible (R)

  • Accountable (A)

  • Consulted (C)

  • Informed (I)

It answers the following questions for each task, milestone, or decision:

  • Who does the work?

  • Who calls the shots?

  • Whose opinion matters?

  • Who needs to stay in the loop?

A responsibility assignment matrix is a tool that clarifies team and stakeholder roles for each project step. It paves the way for smooth collaboration. Everyone knows what they need to do, who they need to talk to, and who has the final say on key decisions and deliverables.

RACI is the most popular RAM framework for assigning roles and responsibilities on projects. Other responsibility matrix models, like RASCI and DACI, adjust the roles for different kinds of work. We'll compare them later in this guide.

A RACI chart breaks roles and responsibilities down further than simple resource assignments. That way, team members and stakeholders know exactly what's expected of them.

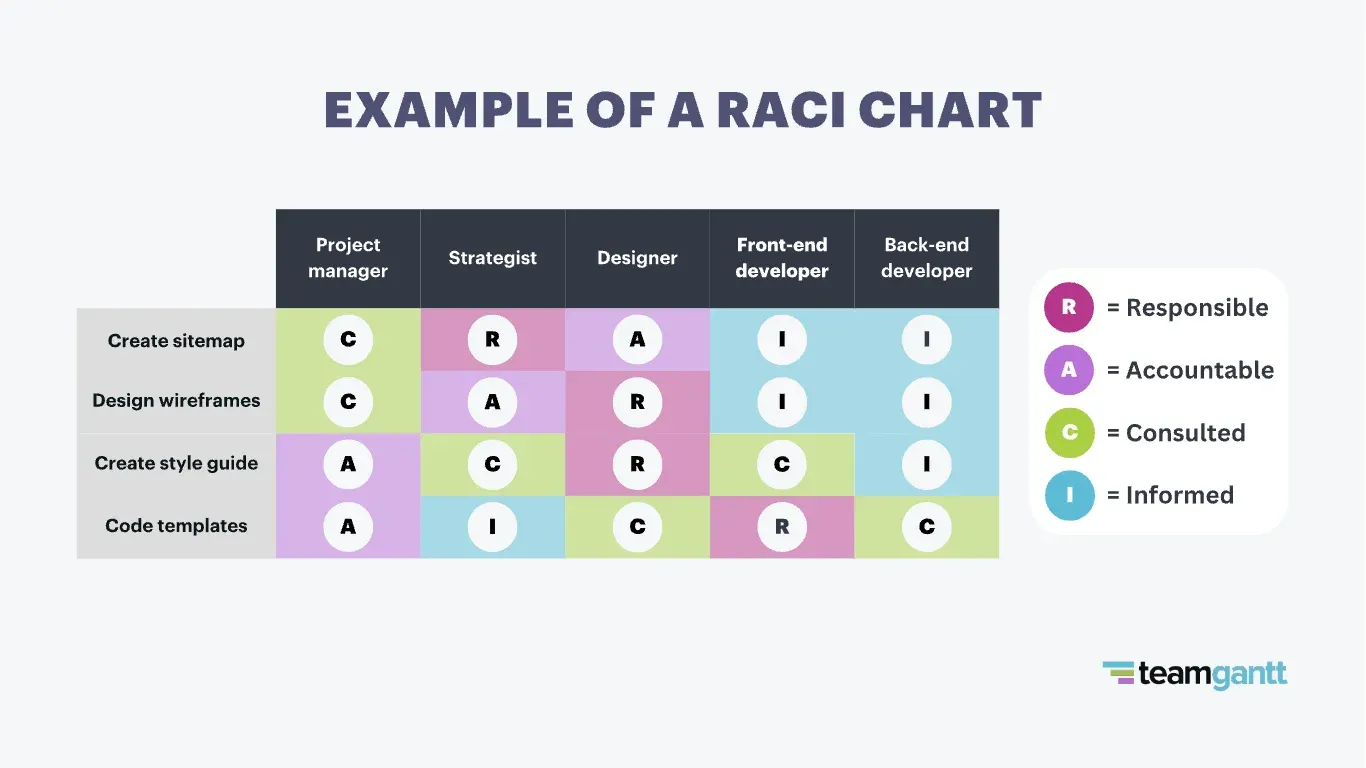

Example of a RACI chart showing team roles across four project tasks. Tasks listed are: Create sitemap, Design wireframes, Create style guide, and Code templates. Columns show Project manager, Strategist, Designer, Front-end developer, and Back-end developer. Each cell indicates responsibility: R = Responsible, A = Accountable, C = Consulted, I = Informed. For instance, the Strategist is Responsible for creating the sitemap, while the Designer is Accountable. The chart uses color-coding: purple for Responsible, pink for Accountable, green for Consulted, and blue for Informed.Example of a simple RACI chart

What do the RACI roles mean?

RACI stands for responsible (R), accountable (A), consulted (C), and informed (I). Here's what each role means:

  • Responsible: The person who does the work to complete the task.

  • Accountable: The person who ultimately answers for the correct and thorough completion of the task.

  • Consulted: People who provide input and feedback before the work is done.

  • Informed: People who need to be kept up to date on progress or decisions.

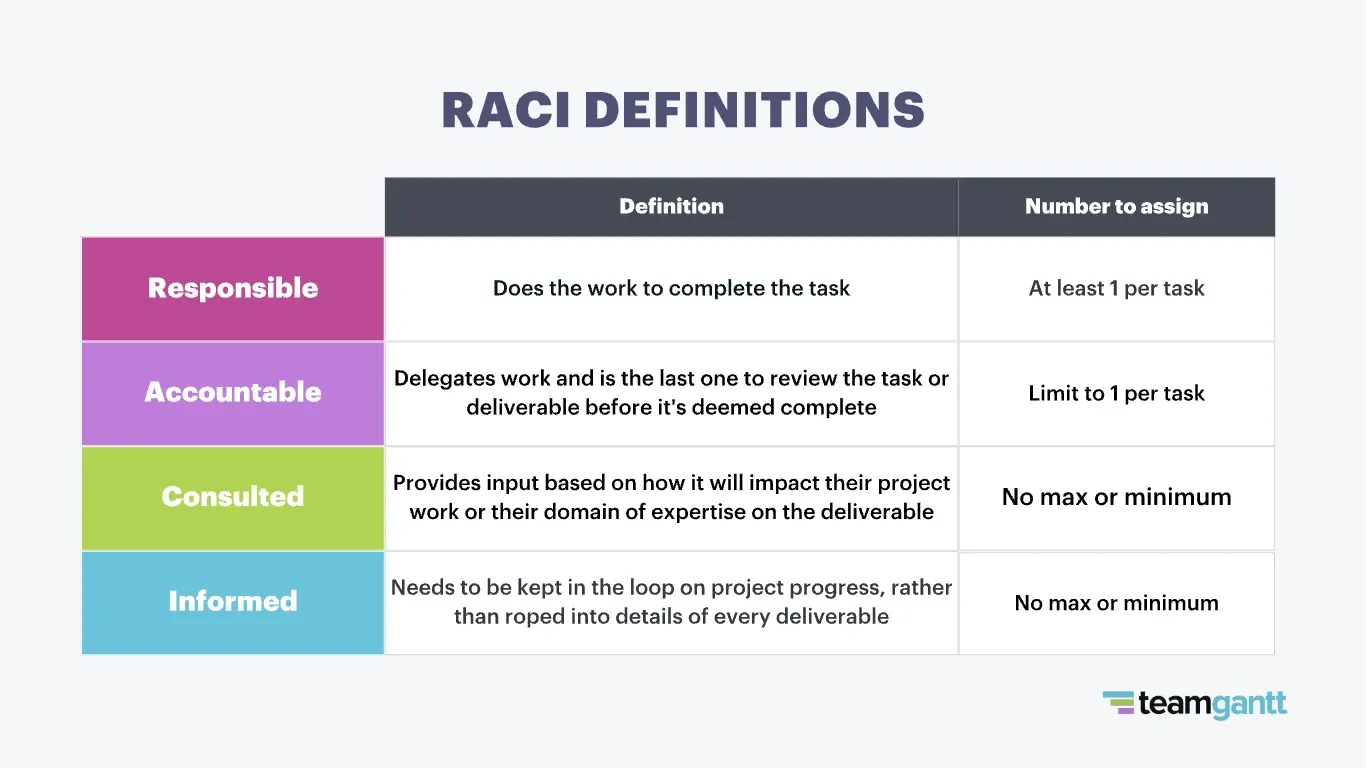

RACI definitions chart with four roles. Responsible: does the work to complete the task, at least one per task. Accountable: delegates work and reviews deliverables before completion, limited to one per task. Consulted: provides input from their expertise, no maximum or minimum. Informed: kept in the loop on progress without detailed involvement, no maximum or minimum. Each role is color-coded: purple for Responsible, pink for Accountable, green for Consulted, blue for Informed.RACI definitions explained

Responsible (R)

This team member does the work to complete the task. Every task needs at least one responsible party, but it's okay to assign more.

Examples of people in the responsible role

  • Content writer

  • Graphic designer

  • UI/UX designer

  • Software developer

  • Business analyst

  • QA specialist

Accountable (A)

This person delegates work and is the last one to review the task or deliverable before it's deemed complete.

On some tasks, the responsible party may also serve as the accountable one. Just be sure you only have one accountable person assigned to each task or deliverable. (It might not be your project manager!)

Examples of people in the accountable role

  • Project manager

  • Product manager

  • Department head

  • Team lead

Consulted (C)

Consulted parties are typically the people who provide input based on their domain of expertise or how a task will impact their future project work.

Examples of people in the consulted role

  • Sales team

  • Software architect

  • Content editor

  • Creative director

  • QA manager

  • Compliance officer

  • Security specialist

  • Legal counsel

Informed (I)

Informed stakeholders simply need to be kept in the loop on project progress. They don't need to be roped into the details of every deliverable.

Examples of people in the informed role

  • Executive leadership

  • External clients

  • Team members assigned to dependent tasks

  • Customer support team

  • Administrative staff

What's the difference between responsible and accountable?

The same person can be both responsible (R) and accountable (A) for a task in RACI—including a project manager.

But they're not one and the same. So what's the difference?

Responsible is a task-oriented designation

  • Responsible applies to the person (or people) actually completing the work.

  • A whole team can be responsible for the execution of one task.

Accountable is an outcome-oriented designation

  • Accountable applies to a single person who must answer for and sign off on the deliverable.

  • This person must also deal with the consequences if a deliverable falls short of goals.

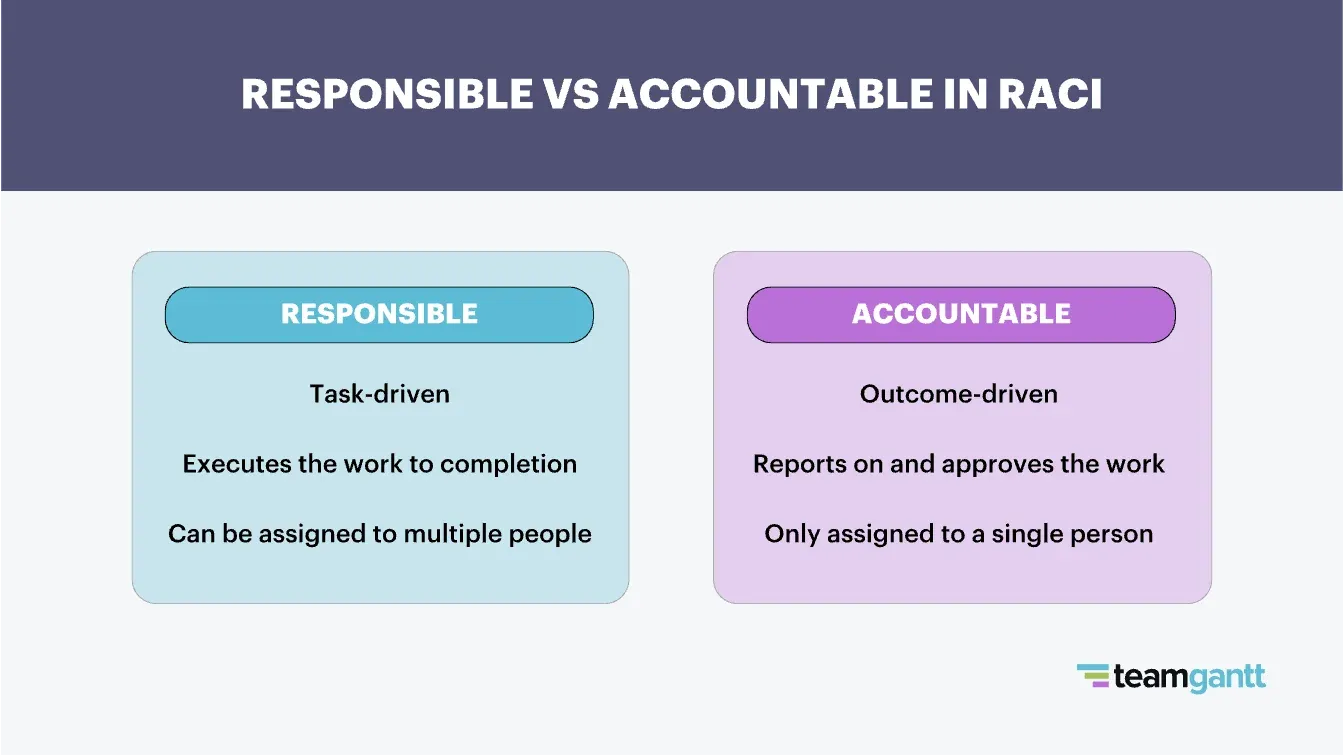

Comparison chart of Responsible vs. Accountable roles in RACI. Responsible is task-driven, executes the work to completion, and can be assigned to multiple people. Accountable is outcome-driven, reports on and approves the work, and is only assigned to one person. Responsible is shown in blue and Accountable in purple.Differences between Responsible vs Accountable in RACIWhat are the benefits of using the RACI model?

  • Reduces confusion and overlap

  • Improves accountability and follow-through

  • Streamlines decision-making

  • Enhances collaboration and communication

  • Delivers measurable efficiency gains

The RACI model brings clarity to project roles and responsibilities. That clarity drives better accountability, faster decisions, and smoother collaboration.

Here are some of the biggest benefits RACI provides.

Reduces confusion and overlap

Without clear roles, work gets duplicated or dropped. McKinsey’s Organizational Health Index found that organizations with clear role definition and accountability are more than three times as likely to achieve top-quartile organizational health.

In practice, that kind of clarity can mean the difference between a stalled initiative and a project that delivers measurable results.

Improves accountability and follow-through

Every task has a designated owner. That means deadlines don't slip and sponsors know exactly who is on the hook for results.

According to PMI Pulse of the Profession (2015), projects with actively engaged executive sponsors are significantly more likely to succeed. Assigning an accountable (A) role ensures sponsors know when they own the decision and stay fully engaged.

Streamlines decision-making

Decision-making is a weakness for most organizations. A McKinsey global survey found that only 20% of companies excel at decision-making, and 61% of decision-making time is used ineffectively.

RACI clarifies who gets to make the call by assigning one accountable (A) person to each task. This reduces bottlenecks that slow projects down.

Enhances collaboration and communication

Consulted (C) and informed (I) roles ensure stakeholders have visibility without being overloaded. This prevents miscommunication and keeps everyone aligned.

In one case involving a building materials distributor, documented by Flevy, redefining the RACI matrix improved operational efficiency by 25%. It also lifted employee satisfaction by 30%, thanks to clearer role alignment and smoother teamwork.

Delivers measurable efficiency gains

In another Flevy case study, a global semiconductor company struggled with project delays and cost overruns. The causes were unclear accountability and slow decision-making.

After redefining its RACI framework, the company cut decision-making time by 15%. It also reduced project delays by 20%.

How to create a RACI chart

Building a RACI chart is simple. The hardest part is deciding which role makes sense for each person involved in each task.

You'll want to map out RACI assignments during the planning stage. This ensures responsibilities are clear before work begins. It also gives you time to adjust for gaps or overlaps.

Here are the basic steps:

  1. List project tasks and deliverables. Write down all key phases, milestones, and tasks in a column on the left side of your chart.

  2. Identify all roles or people involved. Enter project participants across the top row, with one column per person or role.

  3. Assign RACI roles. Give each task a responsible (R), accountable (A), consulted (C), or informed (I) designation for the right people.

  4. Review and adjust for clarity. Look for tasks with no coverage, multiple accountables, or too many consulteds. Fix gaps and bottlenecks.

  5. Finalize and communicate. Share the completed RACI chart with the team. Use it to guide your communication plan.

Be as detailed as needed for your project's complexity and team size. You can use names or job titles in your column headers—whichever is clearest. Every task should end up with at least one responsible and exactly one accountable.

How to build a RACI matrix in Excel

Excel works well for a RACI matrix because rows and columns map neatly to tasks and people. Here's how to build one from a blank workbook:

  1. List tasks in column A. Enter each task, milestone, or decision down the left side. Group tasks by project phase so the matrix is easy to scan.

  2. Add people or roles across row 1. Starting with column B, label each column with a team member or role. Include reviewers, experts, and stakeholders.

  3. Create a roles sheet. Click Insert > Insert Sheet on the Home ribbon. List R, A, C, and I in column A, with role names and definitions beside them.

  4. Add a drop-down list. On your main sheet, go to Data > Data validation and choose List. Set the Source to the 4 letters on your roles sheet.

  5. Color-code with conditional formatting. Go to Conditional Formatting > New Rule and format cells containing R with a background color. Repeat for A, C, and I.

  6. Assign a role to everyone on every task. Copy the drop-down cell across the matrix. Then work down the task list and assign each involved person a role.

If you'd rather skip the setup, our free Excel template already includes the roles sheet, drop-downs, and an example tab.

RACI matrix rules

When your RACI chart is complete, check it against these rules:

  1. Every task has at least one responsible (R). Each task needs a clearly defined owner who will do the work.

  2. Assign exactly one accountable (A). Only one person should be accountable for each task to ensure clear decision-making.

  3. Give everyone a role. Each team member should appear in the chart for every task—even if they are only informed (I).

  4. Balance workloads. No team member should be overloaded with too many responsible (R) tasks.

Best practices for using a RACI chart

Follow these best practices to get the most out of your chart:

  • Focus on tasks, milestones, and decisions. Avoid cluttering the chart with admin items like status meetings.

  • Align tasks with your project plan. This prevents confusion about due dates and details.

  • Keep RACI definitions nearby. Responsible (R), accountable (A), consulted (C), and informed (I) can be easy to forget.

  • Assign roles directly in your project tool. This ensures everyone sees ownership at a glance while the project moves forward.

These habits pay off beyond a single chart. According to PMI's Pulse of the Profession (2020), only 46% of organizations make project management a cultural priority. Those that do deliver more projects on time and on budget.

Real-world examples of the RACI model

Let's look at 3 examples that show how RACI works in practice.

1. Producing a marketing handout

Imagine you're creating a RACI chart for a handout your marketing manager will distribute at an industry conference.

Basic tasks might include

  • Write project brief

  • Create content

  • Design handout

  • Review first draft

  • Update handout

  • Approve final

  • Send to printer

Team members involved

  • Project manager

  • CMO

  • Marketing manager

  • Editorial director

  • Content writer

  • Creative director

  • Designer

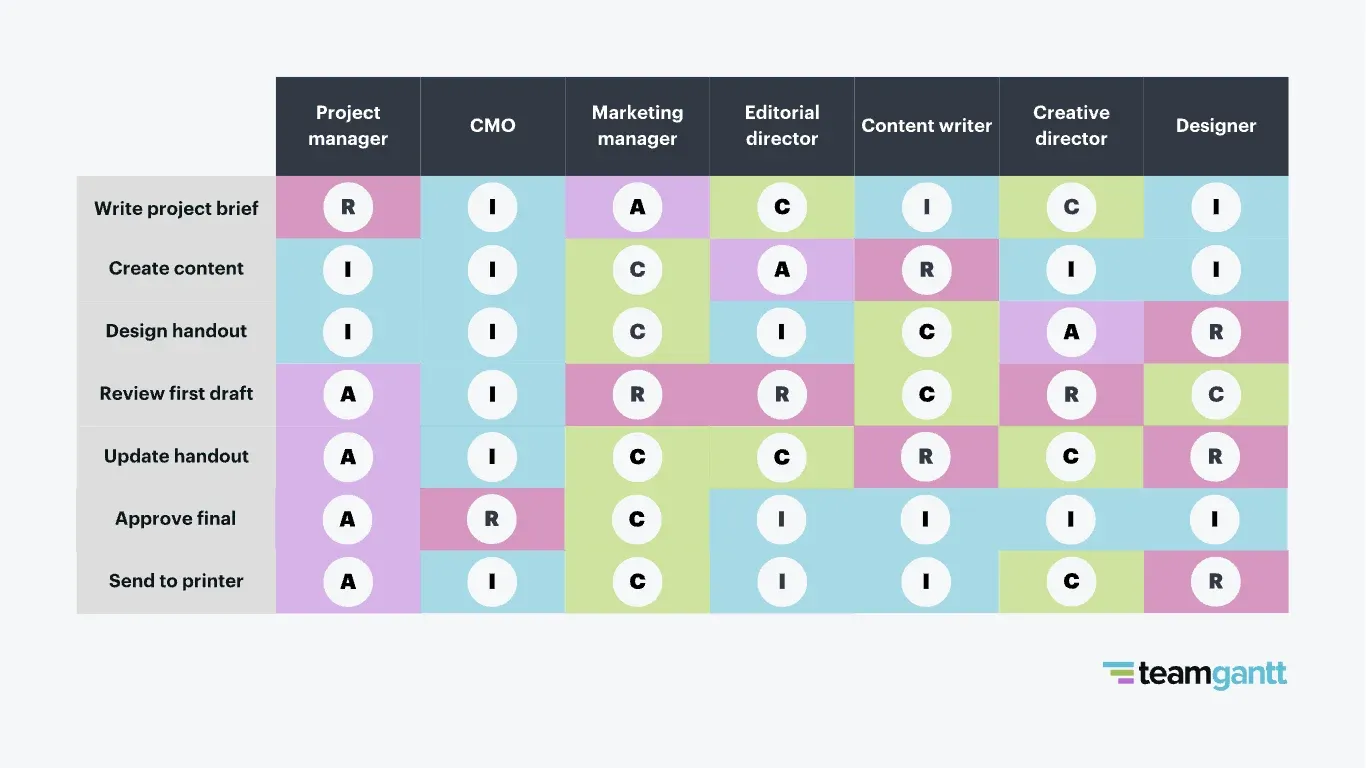

Marketing RACI chart showing team roles across seven tasks: Write project brief, Create content, Design handout, Review first draft, Update handout, Approve final, and Send to printer. Roles include Project manager, CMO, Marketing manager, Editorial director, Content writer, Creative director, and Designer. Each role is marked with R = Responsible, A = Accountable, C = Consulted, or I = Informed. For example, the Project manager is Responsible for writing the project brief, while the Content writer is Responsible for creating content. Responsibilities are color-coded: purple for Accountable, pink for Responsible, green for Consulted, and blue for Informed.Sample RACI chart for the production of a marketing handoutZooming in on the "Create content" task

  • Responsible (R): Content writer actively creates the content.

  • Accountable (A): Editorial director ensures quality and accuracy and reviews against editorial standards.

  • Consulted (C): Marketing manager provides subject matter input and helps fill content gaps.

  • Informed (I): Creative director and designer (because design depends on content), plus project manager and CMO.

2. Developing a new software product

In Agile projects, developers may communicate constantly, but cross-functional teams and senior leaders often need clearer role definition. Here's how RACI might apply.

Market research

  • Responsible (R): Business analyst, marketing manager

  • Accountable (A): Product manager

  • Consulted (C): Sales rep, customer support

  • Informed (I): Project manager, software developers

Requirement gathering

  • Responsible (R): Business analyst

  • Accountable (A): Product manager

  • Consulted (C): UI/UX designer, software architect

  • Informed (I): Project manager, QA analysts

Design and prototyping

  • Responsible (R): UI/UX designer

  • Accountable (A): Product manager

  • Consulted (C): Business analyst, software developers

  • Informed (I): Marketing manager, QA analysts

Software development

  • Responsible (R): Software developers/engineers

  • Accountable (A): Software architect

  • Consulted (C): Product manager, QA analysts

  • Informed (I): Project manager, technical writer

Testing

  • Responsible (R): QA analysts/engineers

  • Accountable (A): Project manager

  • Consulted (C): Software developers, DevOps engineer

  • Informed (I): Product manager, technical writer

Deployment

  • Responsible (R): DevOps engineer

  • Accountable (A): Project manager

  • Consulted (C): Software developers, QA analysts

  • Informed (I): Product manager, customer support

Maintenance

  • Responsible (R): DevOps engineer, software developers

  • Accountable (A): Project manager

  • Consulted (C): QA analysts, technical writer

  • Informed (I): Product manager, customer support

Monitoring

  • Responsible (R): DevOps engineer, QA analysts

  • Accountable (A): Project manager

  • Consulted (C): Software developers, technical writer

  • Informed (I): Product manager, customer support

Marketing and sales

  • Responsible (R): Marketing manager, sales rep

  • Accountable (A): Marketing manager

  • Consulted (C): Product manager, customer support

  • Informed (I): Project manager, software developers

User training

  • Responsible (R): Customer support specialist

  • Accountable (A): Product manager

  • Consulted (C): Technical writer, UI/UX designer

  • Informed (I): All project team members

3. Coordinating a handoff before a company event

RACI also helps at handoffs, where one group's finish date becomes another group's start date. Before a company offsite, catering can't be ordered until the venue confirms final headcount.

A RACI matrix shows who collects the headcount (R) and who answers for the final number (A). It also shows who to consult, like the venue or finance (C), and who needs the date if it moves (I). If the headcount deadline slips, the caterer is already marked informed, so they hear about it before the order cutoff.

The same move works on any project. Find each handoff in your plan, and make sure the next team in line is marked informed.

When should you use a RACI chart?

A RACI chart works for almost any project, but it's especially helpful when:

  • Decision-making or approvals may cause delays

  • Ownership is unclear and conflict arises over who does what

  • Workload distribution feels uneven across team members

  • Turnover occurs and new people need to be onboarded quickly

When might you skip a RACI matrix?

Not every project needs a RACI chart. For example:

  • Small projects where tasks are simple and straightforward

  • Teams with excellent communication who already stay aligned without extra structure

In these cases, you can skip RACI. Just be sure you have a clear project plan in place to guide work.

RACI alternatives: RASCI, DACI, RAPID, and CARS

RACI is the most common responsibility assignment matrix, but several alternatives adjust the roles to fit different kinds of work. Some add a role for support. Others focus on decision-making or simplify communication.

RASCI adds a supportive role

The RASCI model (sometimes written RASIC) adds one extra role to the standard RACI mix. The S stands for supportive.

A supportive team member lends the responsible person a hand with the work. They aren't responsible for the outcome, though. RASCI is a good fit when specialists or helpers contribute to a task but shouldn't own it.

DACI focuses on who drives a decision

DACI stands for driver, approver, contributor, and informed. Teams use it to outline decision-making roles and responsibilities on a project.

In this framework, the project manager or team lead is usually the driver who guides the group to a decision. The approver signs off, contributors share input, and informed people hear the outcome.

RAPID separates authority from accountability

RAPID stands for recommend, agree, perform, input, and decide. It's another decision-making framework, and it's built to define authority vs. accountability.

The recommend role kicks things off by suggesting an action. The decide role has the ultimate say in how things move forward.

CARS combines consulted and informed

CARS stands for communicate, approver, responsible, and support. In this model, the communicate role merges RACI's consulted and informed roles into a single assignment.

Someone in the communicate role lends their expertise and needs to be kept up to date on progress. The approver is the main decision-maker who calls the shots.

Common RACI pitfalls and how to avoid them

Using a RACI chart is simple, but mistakes can limit its effectiveness.

Harvard Business Review notes that accountability often breaks down in complex organizations, where roles overlap and processes cross departments.

Here are 3 pitfalls to watch for:

1. Failing to get buy-in

Without stakeholder alignment, even tools like RACI risk creating confusion.

  • Pitfall: Assigning roles without input from team members or stakeholders.

  • How to avoid it: Walk through assignments together so everyone understands their role. Confirm that the chart removes confusion instead of creating it.

Good stakeholder management starts here. A short review meeting at kickoff surfaces disagreements while they're still easy to fix.

2. Setting it and forgetting it

RACI is not a one-time exercise.

  • Pitfall: Building the chart at project kickoff and never revisiting it.

  • How to avoid it: Review RACI roles during weekly check-ins. Keep the chart accessible so team members can reference it as work progresses.

3. Overcomplicating stakeholder communication

Too many consulted (C) and informed (I) roles can overwhelm communication.

  • Pitfall: Adding long lists of people to every task without a clear plan to update them.

  • How to avoid it: Use lightweight communication methods so informed stakeholders stay up to date without extra meetings.

Free RACI template for Excel

Our free RACI template for Excel gives you a ready-made responsibility assignment matrix, so you don't have to start from scratch. This blank RACI template is fully editable, so you can customize it for any project you manage.

We added drop-downs for assigning RACI roles more easily and included a RACI chart example tab as reference. The example tab is helpful if you need a little extra guidance on your first matrix.

How to manage RACI roles in TeamGantt

A RACI chart is easiest to keep current when it lives in the same place as your schedule. A spreadsheet can hold the matrix, but a separate file is easy to forget once work begins.

That's why we built RACI roles into TeamGantt plans. Here's how to use the online RACI feature on your next project.

Assign RACI roles on the RACI tab

  1. Open your project, and toggle to the RACI tab. Your tasks appear as rows, with a column for each person invited to the project.

  2. Click the cell below each person who needs a role on a task. Then choose one of the RACI options from the drop-down.

View RACI assignments on the Gantt and RACI tabs

You can view RACI assignments in 2 places in TeamGantt.

On the Gantt tab, the RACI value appears in parentheses next to an assigned person's name. It only shows for people assigned to that task, so use the RACI tab to see everyone else.

To see the full matrix, toggle to the RACI tab. It shows everyone's roles on every task, whether or not they're the person doing the work.

Use the Gantt tab for day-to-day ownership and the RACI tab when you review roles at weekly check-ins.

Frequently asked questions about RACI charts

What is the golden rule of a RACI chart?

The golden rule of a RACI chart is that every task should have only one accountable (A) owner. While multiple people can be responsible (R) for completing work, there must be a single point of accountability. That keeps decisions clear and avoids confusion.

Are RACI charts outdated?

No, RACI charts remain valuable for modern, cross-functional projects. They provide a simple, adaptable framework for clarifying roles and preventing delays. Even as teams adopt Agile or hybrid approaches, RACI continues to be used in industries like construction, engineering, and IT.

Who creates the RACI chart?

The project manager usually creates the RACI chart during planning, after the project's work has been broken down into tasks and deliverables. They build the matrix with input from the team, since the people doing the work know where handoffs and reviews happen. Then the people marked accountable confirm their assignments before work begins.

Should a RACI chart use individual names or roles?

Use roles when people may change, and use individual names when each role is filled by one person. Roles persist when people change, so a role-based chart holds up through turnover and is easy to reuse. Names work well when a role is a single person or on small teams. In a project management tool, you assign actual people to tasks, so the RACI matrix shows names.

Does TeamGantt have a built-in RACI feature?

Yes, TeamGantt has a built-in RACI tab where you can assign a RACI role to each person on every task. Those roles also show next to assigned people's names on your Gantt chart. That makes it easy to see who is responsible (R), accountable (A), consulted (C), or informed (I) without switching between tools.

Put your RACI roles right on the schedule

Assign RACI roles to every task in TeamGantt, or start with our free Excel template.
