How to Create a Project Schedule (Plus a Free Excel Template)

L

Laura LaPrad• Updated Nov 15, 2026

Project scheduling is the process of turning a project plan into a dated timeline of tasks and milestones. The finished project schedule shows who owns each task and when it’s due, so anyone can read the order of work at a glance.

This guide walks you through building a project schedule step by step, then keeping it current when work slips.

What is a project schedule?

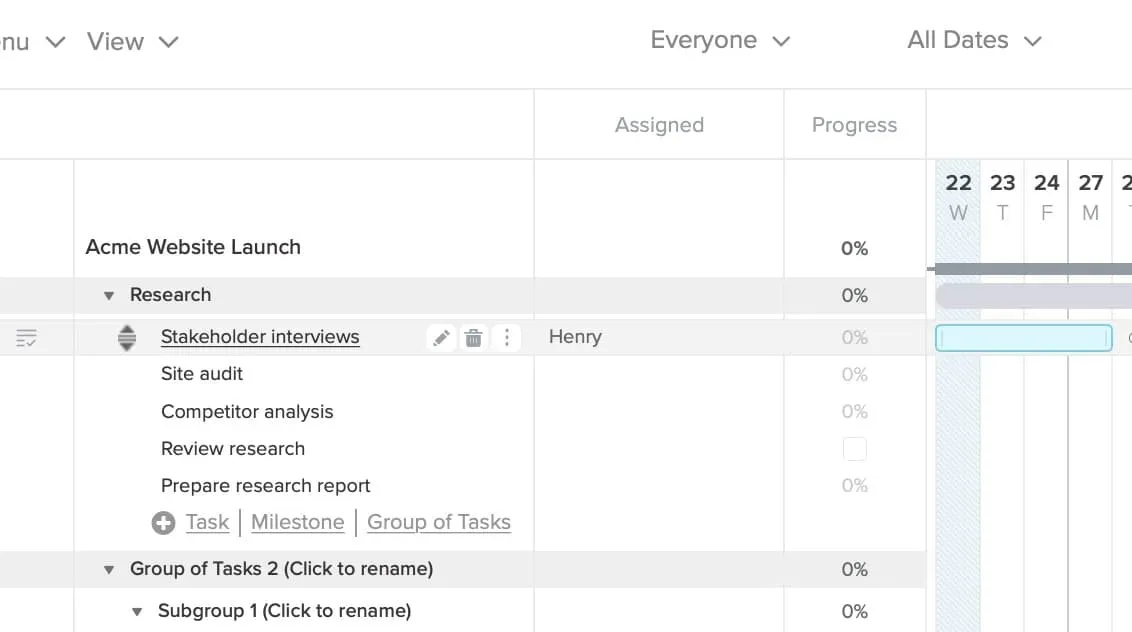

A project schedule is a timeline of every task in a project, who owns it, and when it starts and ends. It’s the plan your team works from day to day, and the one you share when someone asks when the work will be done.

Whether it lives in a spreadsheet or a Gantt chart, every project schedule includes the same core parts:

  • Tasks that break each deliverable into doable work

  • Durations for how long each task takes

  • Start and end dates on a shared calendar

  • Sequence and dependencies that set the order of work

  • Owners who are responsible for each task

  • Milestones that mark key approvals and deadlines

Simplified Gantt chart labeling the six parts of a project schedule: tasks, durations, dates, a dependency, an owner, and a milestone.When one of these parts is missing, the schedule can’t answer the question people ask most: What happens next?

Project schedule vs. project plan vs. project timeline

A project schedule is the time-based part of a larger project plan. The project plan covers how the whole project will run, including scope and budget. The schedule answers a narrower question: Who does what, and by when?

A project timeline is a simpler view of the same schedule: the phases and key dates you’d show at a kickoff. The schedule holds the task-level detail behind it, like owners, durations, and dependencies.

Types of project schedules

Project schedules come in four common levels of detail, and each one serves a different reader. Here’s how they differ:

  • A milestone schedule shows only the key dates, like approvals and launch.

  • A master schedule summarizes the whole project by phase, usually on one page.

  • A detailed schedule lists every task with its owner and dependencies.

  • A look-ahead schedule zooms in on the next 2–6 weeks of near-term work.

Build the detailed schedule first, then roll the other views up from it. Stakeholders usually want the milestone view, while the team works from the detailed one. Keeping every view in one source means nobody maintains two versions that fall out of sync.

How to create a project schedule in 7 steps

These 7 steps help you catch missing work, unrealistic dates, and double-booked teammates before work starts. The steps work the same way in a spreadsheet or a Gantt chart, so start with whichever tool you have open.

1. Define deliverables and scope

Scope defines what “done” means, so settle it before you set a single date. List the deliverables the project must produce, like a published pricing page or a signed vendor contract. Then break each deliverable into smaller pieces with a work breakdown structure (WBS), which is a tree of deliverables and the work under them.

Skipping this step is how surprise work shows up in week four. If a deliverable isn’t on the list, nobody plans time for it.

2. Break deliverables into tasks

A good task has one owner and a clear finish line. Name each task with a verb and a noun, like “Draft launch email” or “Test checkout flow,” so anyone can tell when it’s done. Split any task that’s too big to estimate with confidence.

Vague tasks are where handoffs fail. A task called “Website” never quite finishes, while “Publish pricing page” has an obvious end that the next person can act on.

3. Estimate durations

The most reliable duration estimates come from the person who’ll do the work. Ask them how many working days the task takes, then compare their answer to similar tasks on past projects. Our project estimation guide covers more methods if you’re starting from scratch.

Add buffer only to the risky tasks. Padding everything stretches the timeline and hides where the real uncertainty sits. A task waiting on an outside approval deserves extra days, while a routine task your team has done many times usually doesn’t.

4. Sequence tasks and set dependencies

A dependency is a link that shows which task can’t start or finish until another one does. Dependencies turn a task list into a schedule because they show what moves when a date changes. Four dependency types cover nearly every situation:

  • Finish-to-start means a task starts after the one before it finishes, and it’s the default you’ll use most.

  • Start-to-start means the dependent task can start once the first task has started, like copywriting that begins once design is underway.

  • Finish-to-finish means the dependent task can finish once the first task has finished, like testing that wraps up after development does.

  • Start-to-finish means a task can’t finish until another starts, like an old tool that stays live until the new one launches.

Add a dependency only when one task’s timing truly controls another’s. Dependencies added “just in case” make every small change ripple through the plan. Once that happens a few times, the team stops trusting the dates.

5. Assign owners and check workload

Every task needs a clear owner. Several people can contribute, but name one person who confirms the task is done and tells the next person it’s ready.

Before you commit to dates, check whether anyone is booked on too many overlapping tasks. If someone is double-booked, reassign a task or shift its dates now, while the change is cheap.

6. Add milestones

A project milestone marks a key approval, handoff, or deadline. It has no duration, since it marks a checkpoint, not a stretch of work. Milestones give stakeholders clear status checks without asking them to read every task. Good candidates include:

  • Approvals and sign-offs

  • Handoffs between teams

  • Launch or go-live dates

  • External deadlines you don’t control

7. Review, share, and save a baseline

A schedule is ready when the people doing the work agree the dates are realistic. Walk through it with the team task by task, and fix anything that doesn’t match how the work really happens.

Then share a single version that everyone works from. Email attachments create copies, and copies drift.

Finally, save a schedule baseline before work starts. A baseline is a snapshot of your approved plan, so you can measure what changed later and explain why.

Gantt chart comparing a baseline schedule with the current schedule after one task slips three days and pushes go-live back.

Project scheduling techniques

Project scheduling techniques are methods for setting and protecting dates, and you’ll usually combine a few. The right mix depends on how certain your durations are and how fixed your deadline is.

Technique

What it does

Best when

Gantt chart

Shows tasks as bars on a timeline, with dependencies between them

Everyone needs to read the plan at a glance

Critical path method (CPM)

Traces the longest chain of dependent tasks, which sets the finish date

The deadline is fixed and late tasks are costly

PERT (three-point estimating)

Blends three estimates per task into one weighted duration

Durations are uncertain or the work is new to the team

Rolling wave planning

Plans near-term work in detail and later phases in outline

Later phases depend on what you learn early

Critical chain

Accounts for limited resources and uses shared time buffers to protect the finish date

Tasks compete for the same people or equipment, and durations are uncertain

Resource leveling

Shifts tasks so no one is booked beyond capacity

The same few people work across several projects

Schedule compression

Shortens the timeline by overlapping tasks (fast-tracking) or adding people (crashing)

You must pull in a date and can accept more risk or cost

Most teams only need two or three of these. Track the critical path when a late task would move your finish date. Save three-point estimates for your riskiest tasks, where you have little past work to base estimates on. And when later tasks depend on decisions you haven’t made yet, plan them as rolling waves, adding detail a few weeks out.

Project scheduling examples

These two examples show how a project schedule helps you make decisions: what needs to move when a task slips and what needs to happen now to keep upcoming work on track.

Software rollout: A 6-week schedule with one slip

A worked example makes the critical path easy to see. Here’s a 6-week schedule for rolling out a new help desk tool to an internal support team, measured in working days.

Task

Owner

Duration

Depends on

Working days

Confirm requirements

Operations lead

3 days

None

1–3

Configure the help desk tool

IT admin

6 days

Confirm requirements

4–9

Write training guides

Operations lead

6 days

Confirm requirements

4–9

Migrate existing tickets

IT admin

5 days

Configure the help desk tool

10–14

Run a pilot with one team

Support manager

5 days

Migrate existing tickets; Write training guides

15–19

Pilot sign-off (milestone)

Support manager

0 days

Run a pilot with one team

19

Fix pilot issues

IT admin

3 days

Pilot sign-off

20–22

Train all support staff

Operations lead

3 days

Fix pilot issues

23–25

Go-live (milestone)

Operations lead

0 days

Train all support staff

25

Collect feedback and adjust

Support manager

5 days

Go-live

26–30

The critical path runs through every task except the training guides. Those guides have 5 days of float, which is the time a task can slip before it delays anything else.

Gantt chart of a six-week rollout with the critical path highlighted and one non-critical task showing five days of float.Now say ticket migration slips 3 days. Here’s what that one change affects:

  • The pilot starts on day 18 instead of day 15

  • Pilot sign-off moves from day 19 to day 22

  • Go-live moves from day 25 to day 28

  • Feedback collection ends on day 33, past the 6-week window

If the training guides slip 3 days instead, nothing else moves. They’d finish on day 12, still ahead of the pilot on day 15. The training guides can slip 5 working days without delaying the pilot. A longer delay would push the pilot and the project finish date.

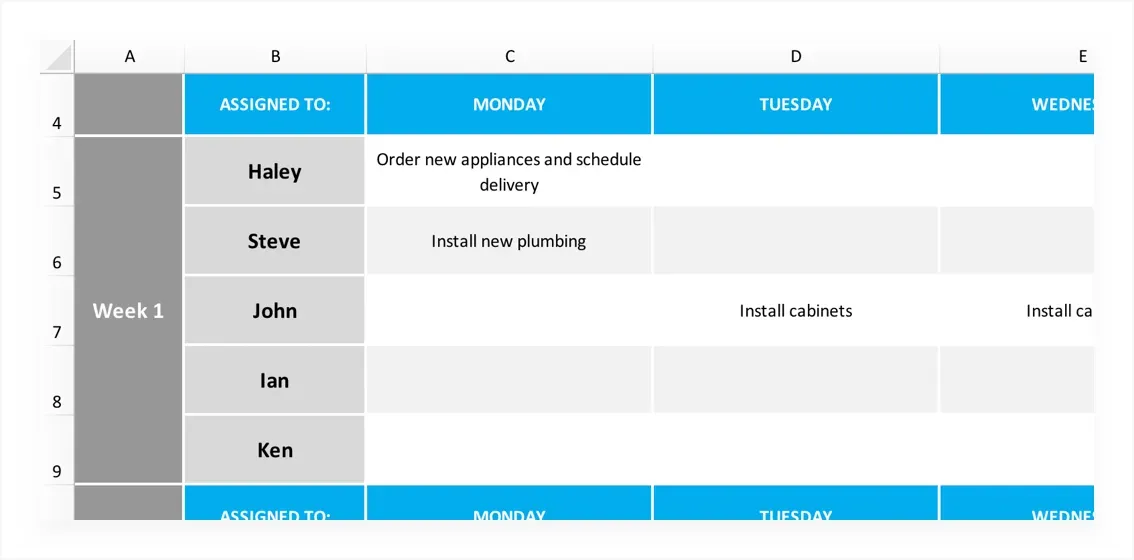

Construction: A 2-week lookahead

If rough-in runs late, the inspection and drywall dates may need to move too. Put those handoffs on the schedule so the next trade knows when the site will be ready.

A 2-week look-ahead keeps a construction schedule tied to the work that’s coming next. Picture a kitchen remodel where demolition and rough-in fill the next two weeks. The look-ahead also holds one task that’s easy to miss: approving the custom cabinet order.

Custom cabinets are a long-lead item, so the order has to go in weeks before install. Put that lead time on the schedule as its own bar, ending right before the cabinet install task it supports. If the order goes in late, the lead-time bar pushes past the install date, so you see the conflict as soon as it happens, not on install day.

Two-week look-ahead for a kitchen remodel showing a cabinet order approved now, with a long lead-time bar that ends right before installation outside the two-week window.In TeamGantt Builder Edition, lookaheads filter the schedule to a 2–6 week window. Material lead time tracking lets you see each order alongside the task it supports.

The same rule works for any team. Any input with a lead time, like a vendor contract or a legal review, belongs on the schedule before the task that needs it.

If you’re looking for a jumping off point, check out our construction schedule example or download even more construction project management templates.

How to keep a project schedule on track when work slips

A task runs late. An approval takes longer than expected. Before long, the dates on your schedule don’t match the work. That's why it's important to set aside time each week to update progress and review what’s changed, then share the latest schedule with your team. Here’s a simple routine to follow:

  1. Update progress at the same time each week. Mark finished work and adjust dates for anything in progress.

  2. Log every change in three parts: what changed, why it changed, and what it affects.

  3. Check the critical path and the next milestone first. Those dates tell you whether the finish date is at risk.

  4. Re-share the one live version instead of sending a new file. Weekly attachments mean someone is always reading last week’s plan.

  5. Save a new, named baseline when scope or the agreed deadline changes. For everyday slips, keep comparing against the approved plan, so the drift stays visible.

Keeping one live version is harder in a spreadsheet, because every emailed copy becomes its own version. In TeamGantt, every baseline you save stays available, so you can compare the current plan against any of them. A view-only share link lets stakeholders see the current plan without waiting for a new file.

How to use our Excel project schedule template

Download TeamGantt’s free project scheduling Excel template, add your team, and map out the next two weeks of work. Here’s how to set it up.

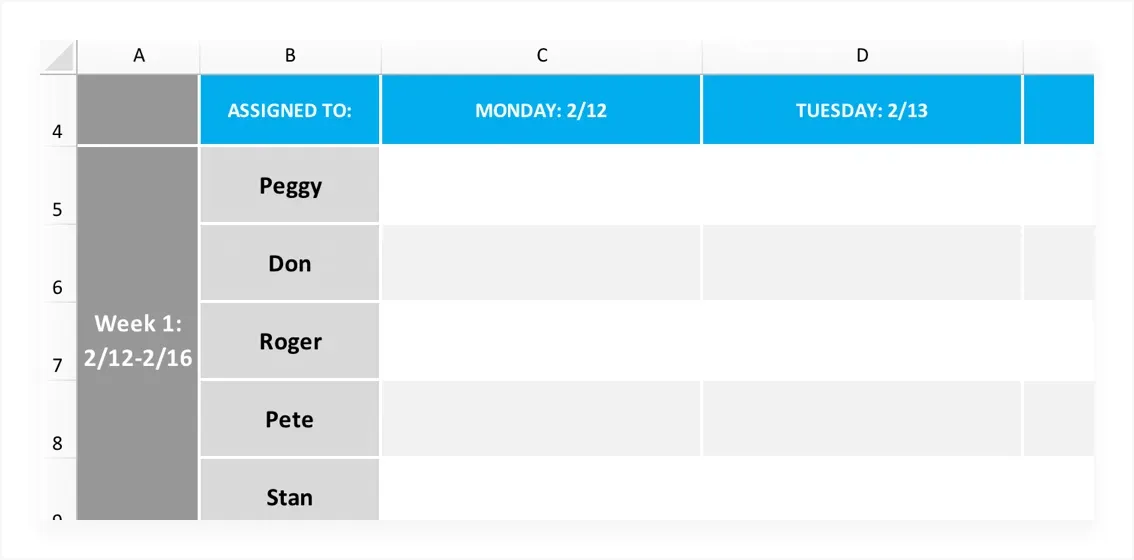

Setting project schedule dates

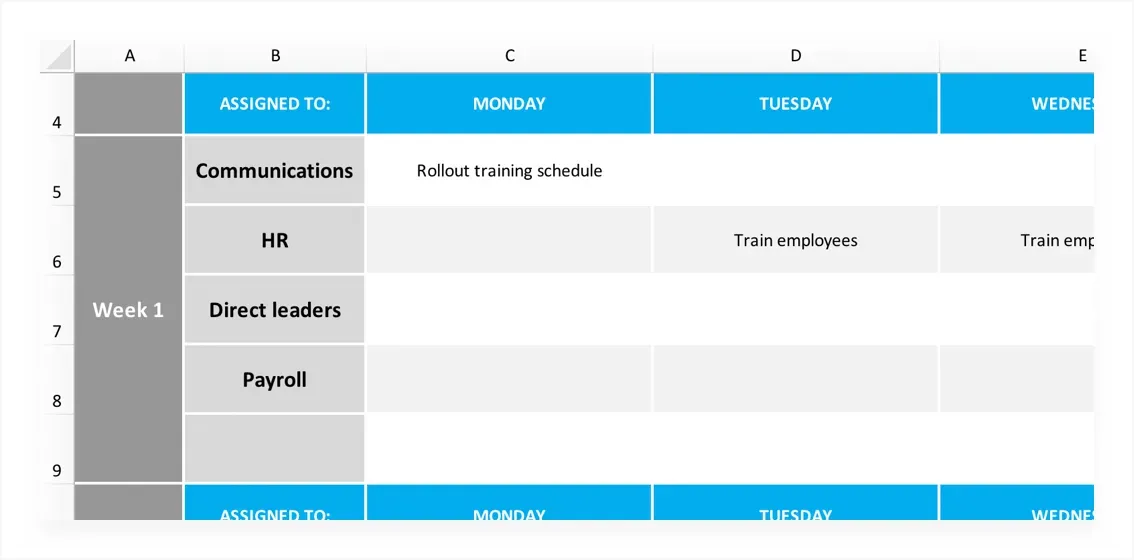

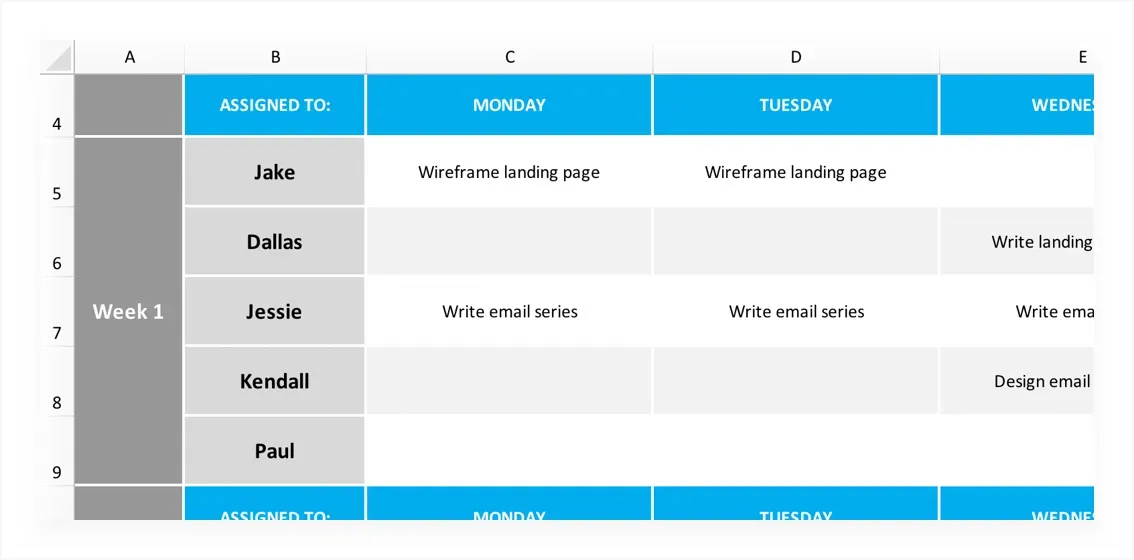

Use the template to show who’s doing what over the next two weeks. Add the dates so nobody has to guess which Monday you mean.

Because the template covers two weeks, it works as a ready-made 2-week look-ahead. At the end of each week, clear the finished week and add the next one so the view keeps rolling forward.

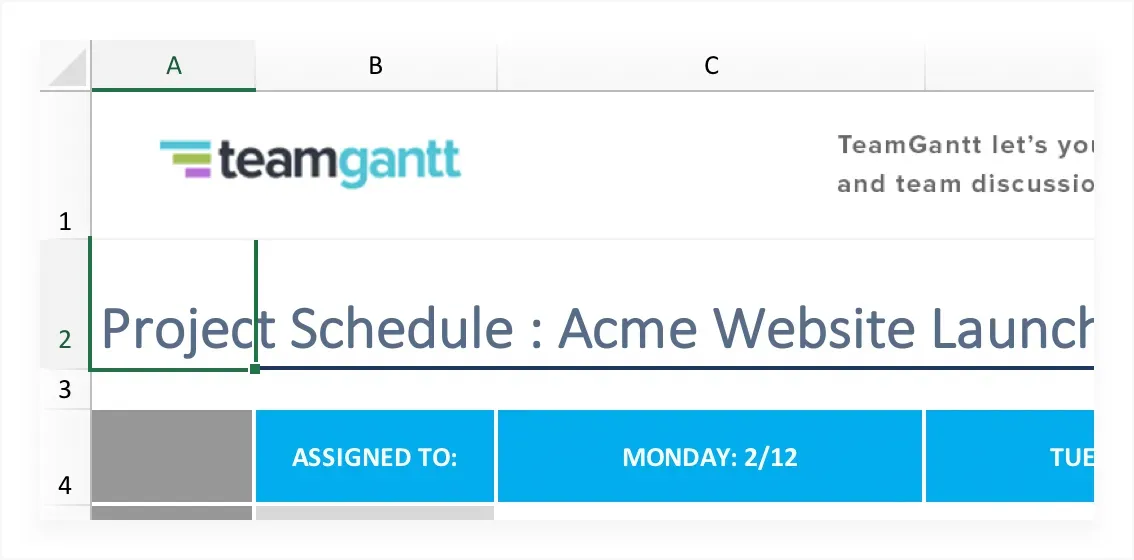

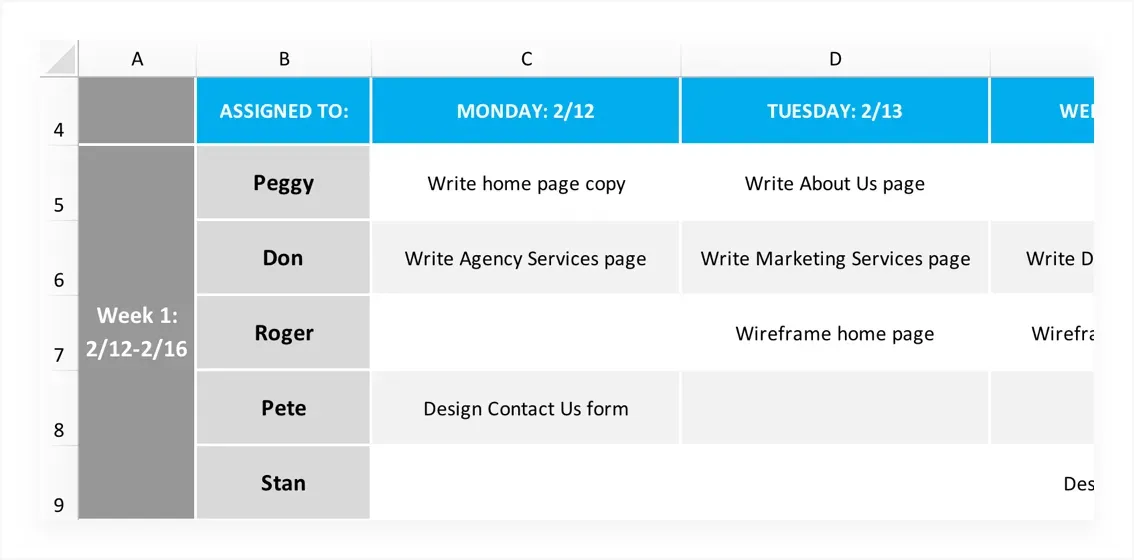

  1. Start by specifying the date ranges for Week 1 and Week 2 in the far left column.

  2. Then, enter the date that corresponds to each weekday featured on the project schedule spreadsheet.

Adding project resources

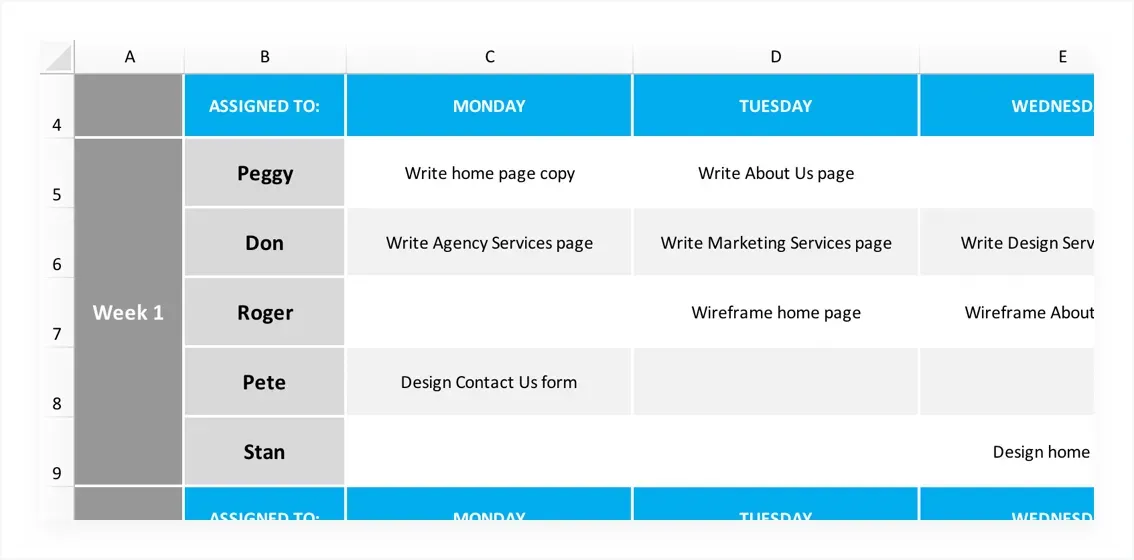

Unless you’re working solo, you’ll have people helping you get the job done. List each team member or department who will contribute to the project in the Assigned to column.

Assigning project tasks

Now that you’ve added all your resources, you’re ready to assign work. Enter a descriptive name for the tasks you want each team member to accomplish below the corresponding day of the week.

Customizing your project schedule

Adding titles

Got lots of projects in the works? Keep your projects organized by giving each schedule its own specific title.

  1. To add or edit the title of your project schedule template, double-click your cursor into cell A2.

  2. Enter a new title for your project schedule template. Feel free to include the project name in your title so there’s no doubt about what this schedule covers.

  3. Format the header text using the same formatting tools you’d use to format any other text in the worksheet.

Changing colors

Want your schedule to be easier to scan? Use different colors to organize tasks by team member, or apply your own brand colors to the template.

  1. Click to highlight the cell, row, or column you want to change.

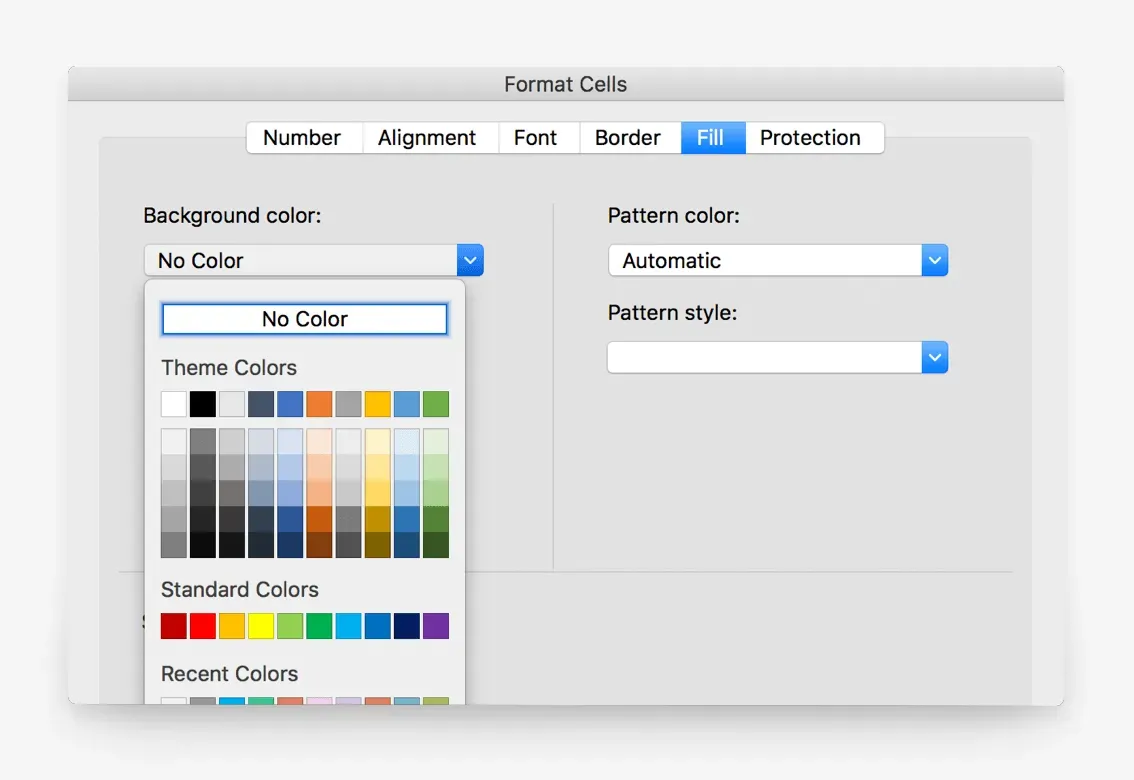

  2. Go to Format > Cells, and select the Fill tab.

  3. Click on the Background Color dropdown, and choose the new color you want to apply to the cell, row, or column you’ve highlighted.

Adding rows/columns

We’ve based this project timeline template on a two-week schedule that covers weekdays only. But you might want to expand your timeline to cover a month’s worth of tasks, weekends included. Or perhaps you’ve got a big crew to manage and need to add more people to your project schedule.

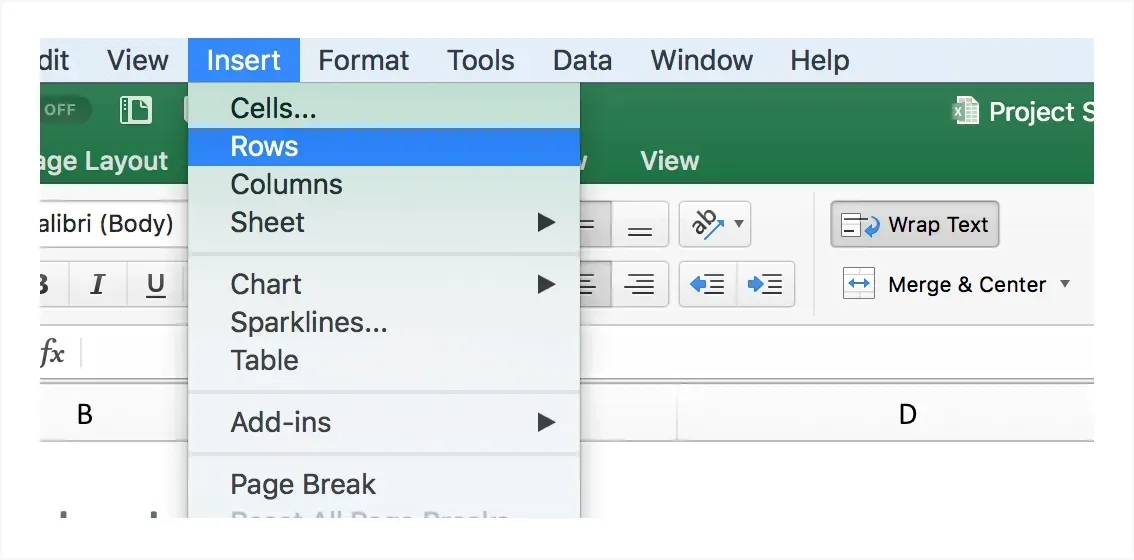

  1. To insert a new row, click Insert > Rows. A new row will be added above the one you currently have selected, using the same formulas and formatting of the row above.

  2. To insert a new column, go to Insert > Columns. A new column will be added to the left of the one you currently have selected, using the same formulas and formatting of the column to the left.

Removing rows/columns

Feel bogged down by extra details? Here’s how to remove rows and columns you don’t need.

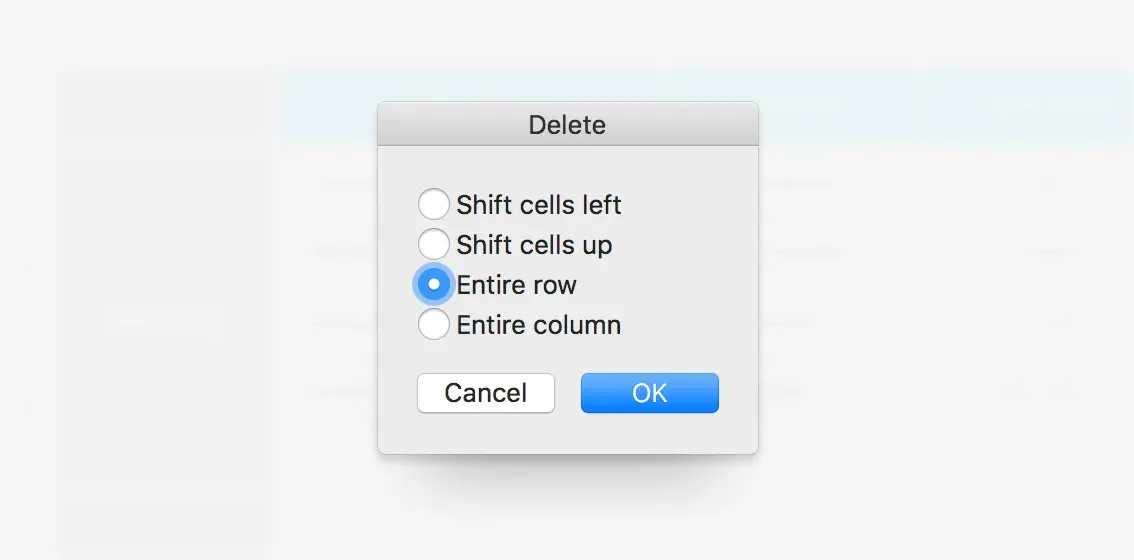

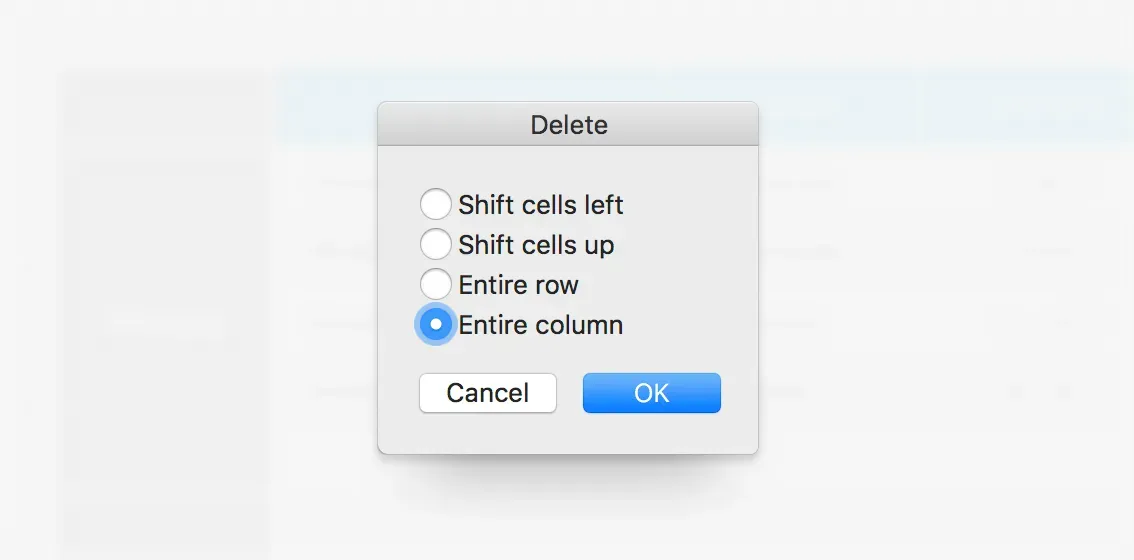

  1. To delete an existing row, click on the row you want to remove. Go to Edit > Delete, and choose Entire Row.

  2. To delete an existing column, click on the column you want to remove. Go to Edit > Delete, and choose Entire Column.

You can swap in your own logo in two steps.

  1. Right-click on the TeamGantt logo/header image in row 1, and select Change Picture.

  2. Choose the image file you want to add to the worksheet, and click the Insert button.

Printing the project schedule

Need a copy for the wall or your next team meeting?

  1. Start by setting the print area. Highlight all the cells you want to print out, then go to File > Print Area > Set Print Area.

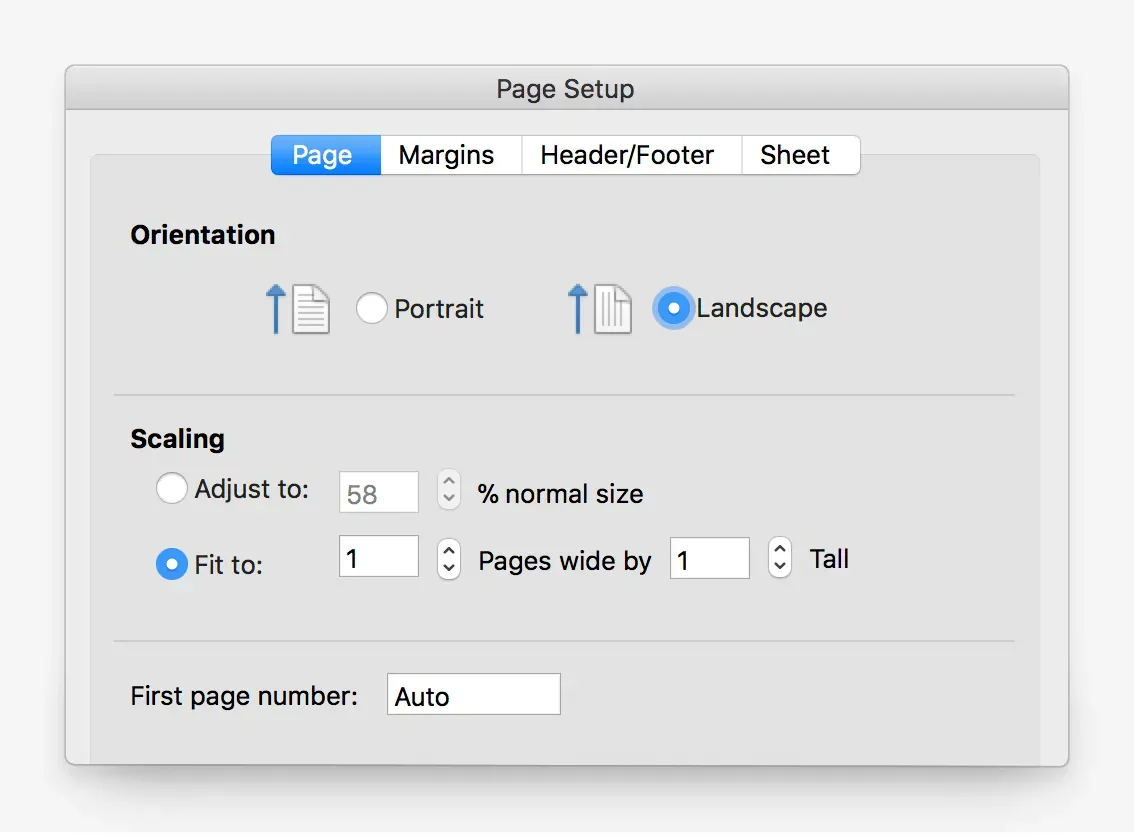

  2. If you want to adjust the scale of the project schedule to fit on a single page, go to File > Page Setup, and select the Page tab.

  3. Once you’ve set the print area and adjusted the scale of your project schedule, you’re ready to send it to the printer. Click File > Print.

Make a project schedule in 5 minutes with TeamGantt

If you’d rather skip the spreadsheet, build your schedule in TeamGantt, where your team’s updates show up in real time and everyone sees the latest plan. Here’s how to set up your first schedule in TeamGantt.

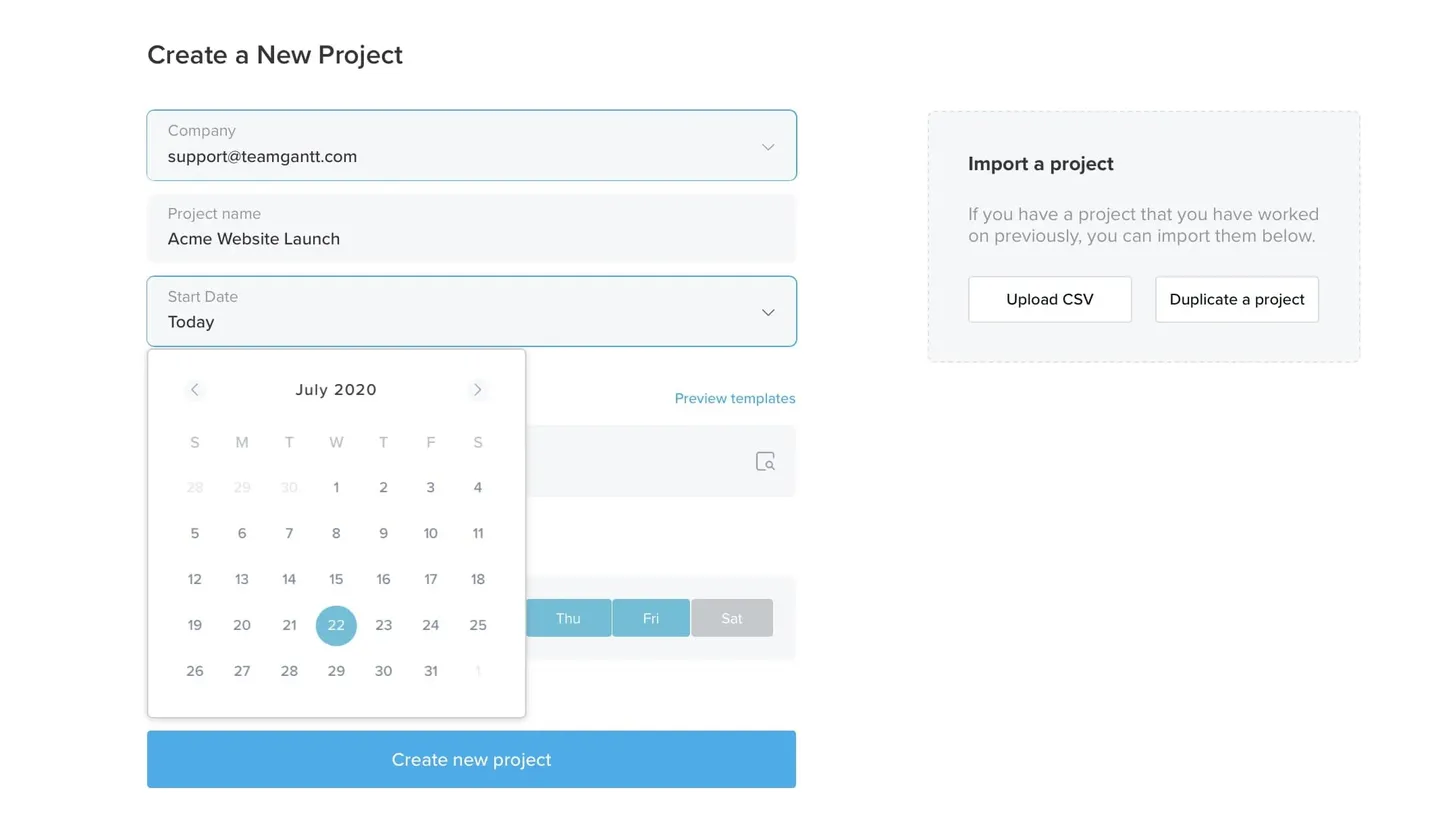

  1. Create a project. Name it, pick a start date, and choose how to begin: a blank project, one of our Gantt chart templates, a CSV or MPP import of the task list you already have, or AI.

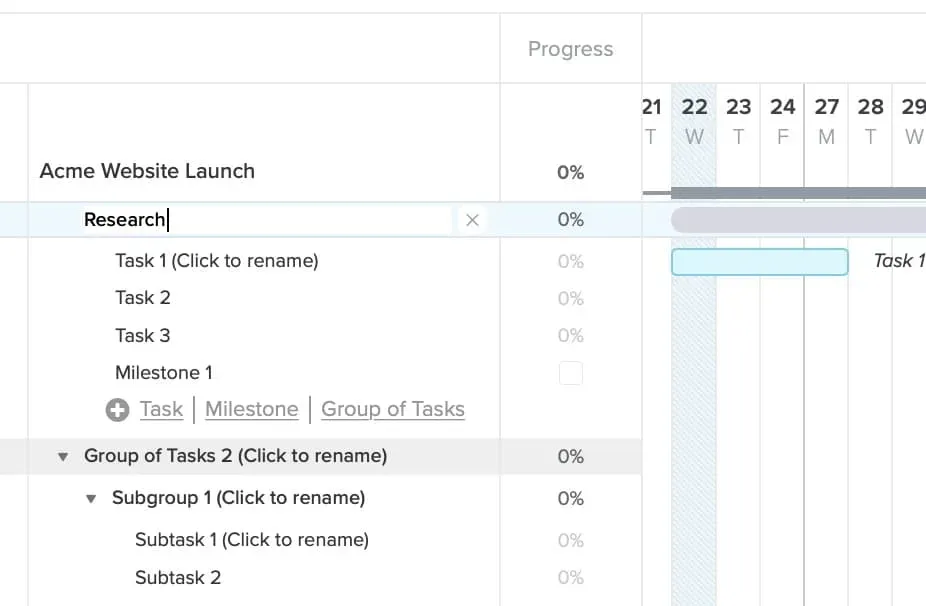

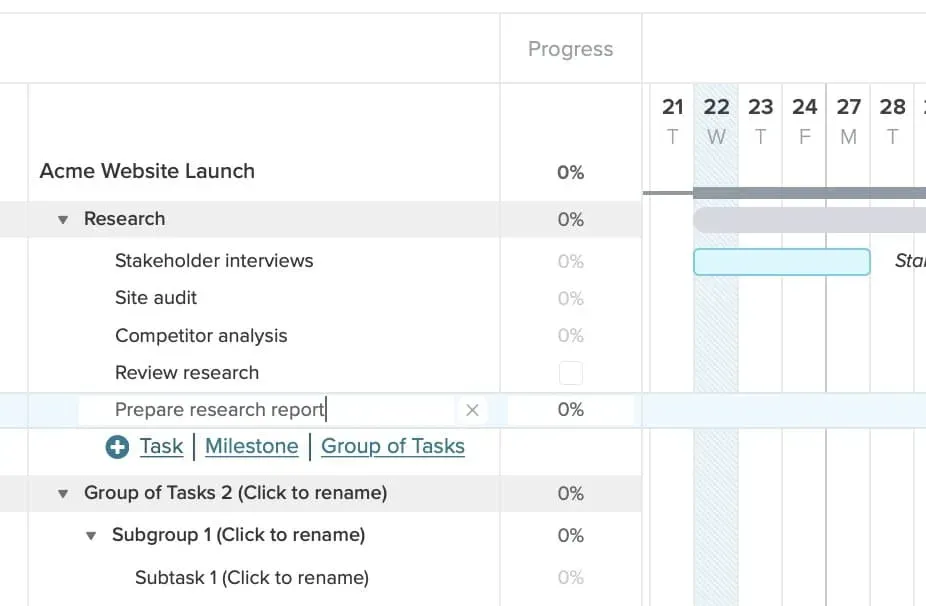

  2. Add task groups and tasks. Use groups for phases or teams, then add the tasks under each one.

  3. Set dates. Drag a task bar to move it, or drag either end to change its duration.

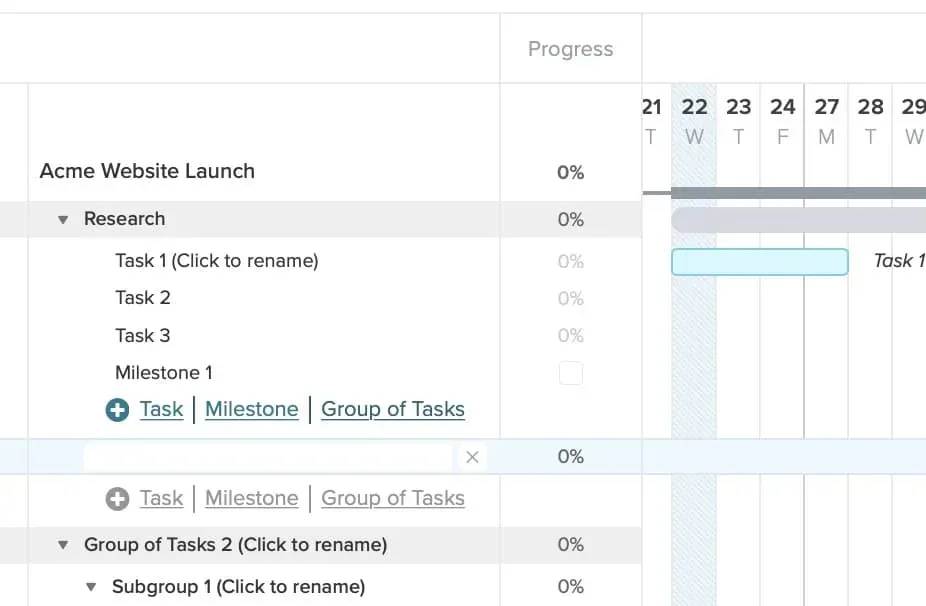

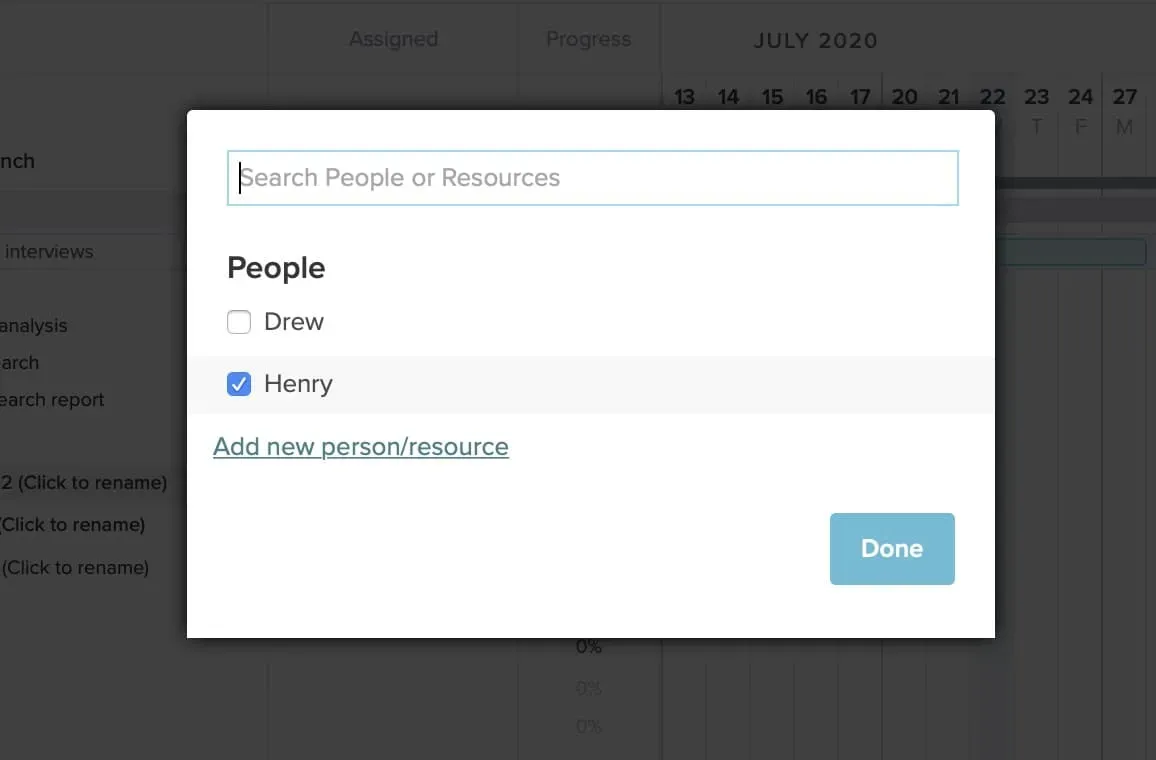

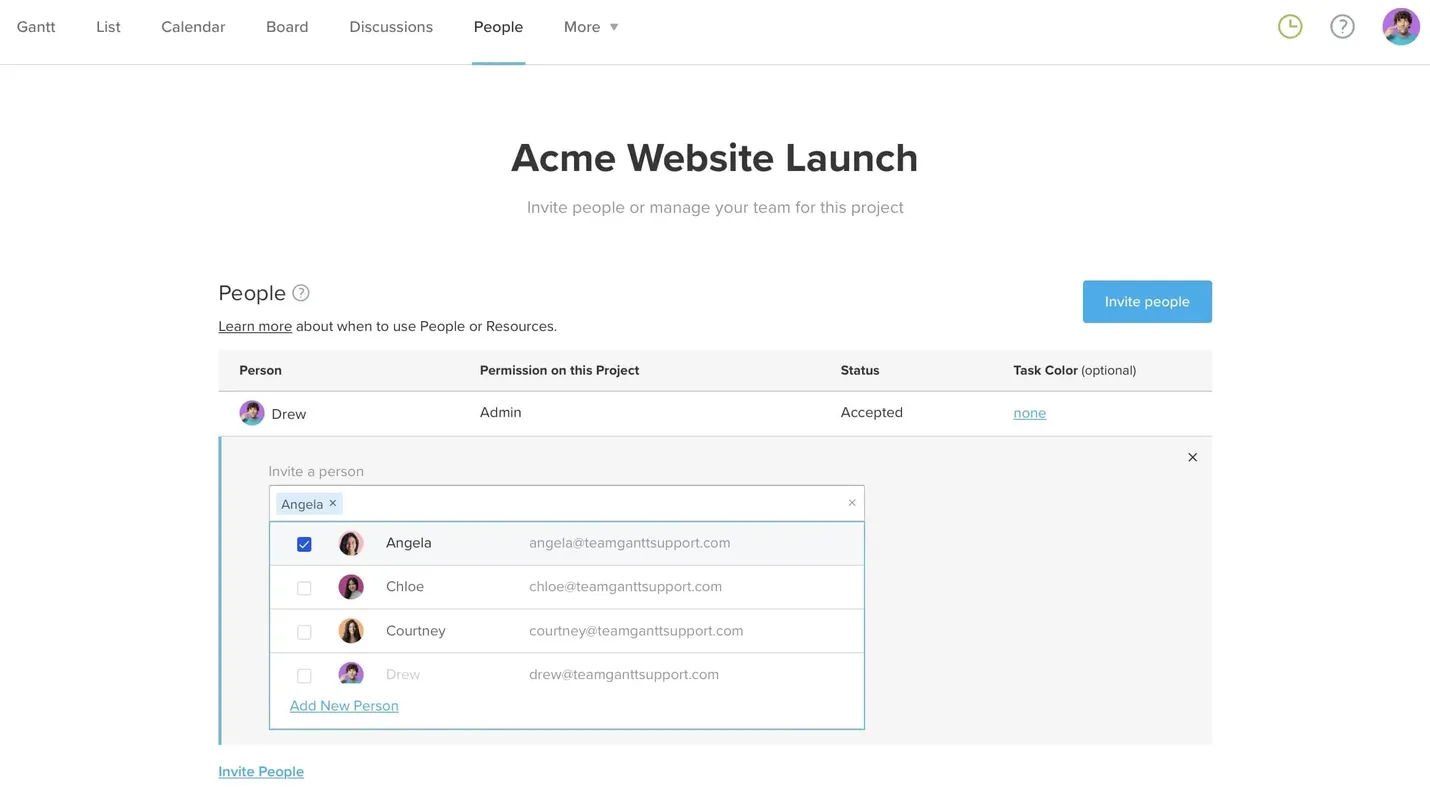

  4. Assign owners. Invite your team, assign each task, and check Workloads to see who’s overbooked before you share the schedule.

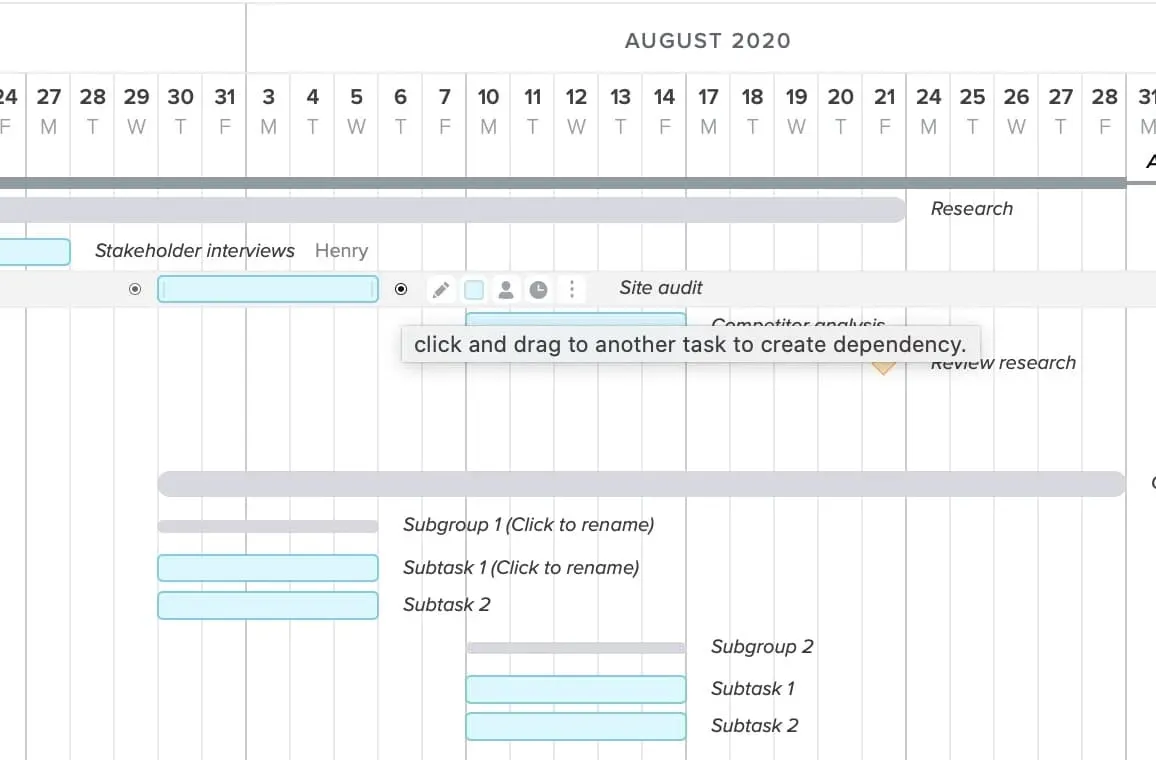

  5. Link dependencies. Connect tasks that have to happen in order. When you drag a task to a new date, its dependent tasks move with it, so you can test a slip and see which milestones move.

Project scheduling alternatives: Excel vs. scheduling software

A spreadsheet works well for a short schedule that one person maintains, like the two-week view in our Excel template. But when one task slips, you’ll need to check which other tasks it affects and adjust those dates yourself.

Scheduling software makes those changes easier to manage. Task dependencies connect related dates, and a shared schedule gives your team one place to update progress and check what’s next. It’s worth considering when you’re juggling frequent changes or several people need to update the plan.

For a side-by-side look, see how TeamGantt compares to Microsoft Excel.

If a spreadsheet fits your project for now, try one of these templates:

Project scheduling FAQs

What’s the difference between a project plan and a project schedule?

A project plan describes how the whole project will run, including scope, budget, and how the team will communicate. The project schedule is the time-based part that turns the plan into dated tasks with owners.

What are the levels of project schedules?

Project schedules usually come in four levels of detail: a milestone schedule (key dates only), a master schedule (phases on one page), a detailed schedule (every task with owners and dependencies), and a look-ahead schedule (the next 2–6 weeks). Stakeholders tend to read the milestone or master level, while the team works from the detailed or look-ahead level.

What is a look-ahead schedule?

A look-ahead schedule is a short view of the next 2–6 weeks of work, pulled from the full project schedule. Teams review it weekly to confirm that the people, materials, and approvals for upcoming tasks are ready.

What are the steps of project scheduling?

Project scheduling follows 7 steps:
  1. Define deliverables and scope, so everyone agrees on what “done” means.
  2. Break deliverables into tasks, each with one owner and a clear finish line.
  3. Estimate durations with the people who’ll do the work.
  4. Sequence tasks and set dependencies, so you can see what moves when a date changes.
  5. Assign owners and check workload before you commit to dates.
  6. Add milestones for approvals, handoffs, and launch.
  7. Review, share, and save a baseline, so you can measure what changes later.
After that, update progress weekly and compare it against your baseline when dates slip.

Can you make a project schedule in Excel?

Yes. Our free project schedule template for Excel covers two weeks of work by person and day. Spreadsheets don’t link dependent tasks, though, so you’ll move related dates by hand when something slips.

How often should you update a project schedule?

Update your project schedule once a week at a set time, and again whenever a milestone date changes. A fixed rhythm keeps the schedule trustworthy because everyone knows how fresh the dates are.

Build a schedule that survives the first slip
